Future Coast Bude

Share Future Coast Bude on Facebook Share Future Coast Bude on Twitter Share Future Coast Bude on Linkedin Email Future Coast Bude link

The Future Coast Bude project is funded by Defra as part of the £200 million Flood and Coastal Innovation Programme (FCIP), which is managed by the Environment Agency. The programme will drive innovation in flood and coastal resilience and adaptation to a changing climate. Future Coast Bude is one of several projects around the country funded through the Coastal Transition Accelerator Programme (CTAP) portion of this fund.

The approach to how we address a changing coastline for Bude (and the country) are set out in national plans known as the Shoreline Management Plan. The aim of Future Coast Bude is

The Future Coast Bude project is funded by Defra as part of the £200 million Flood and Coastal Innovation Programme (FCIP), which is managed by the Environment Agency. The programme will drive innovation in flood and coastal resilience and adaptation to a changing climate. Future Coast Bude is one of several projects around the country funded through the Coastal Transition Accelerator Programme (CTAP) portion of this fund.

The approach to how we address a changing coastline for Bude (and the country) are set out in national plans known as the Shoreline Management Plan. The aim of Future Coast Bude is to encourage the more sustainable use and development of the coastal fringe in line with the national plan, whilst considering the social and economic challenges presented by a naturally changing coastal environment.

What is the Coastal Transition Accelerator Programme (CTAP)?

The Coastal Transition Accelerator Programme (CTAP) helps communities to plan for coastal change in the long term, including:

  • interventions such as improving and replacing damaged community infrastructure like beach access or coastal transport links,
  • repurposing land in coastal erosion zones for different uses, and
  • restoring and creating habitats to include green buffer zones.

Local authorities in the South West have been allocated £6 million in funding to improve the resilience of communities to the effects of coastal erosion and benefit the local economy. Bude is one of only two communities in the South West who will share this funding. For Bude the project will be delivered by Cornwall Council supported by the Environment Agency.

What can the £3 million funding be used for?

The funding can be used to promote adaptation actions to help communities transition away from an eroding coastline. Things the Future Coast Bude funding can be spent on include:

  • Moving structures, amenities and properties away from risk at the coast
  • Changing land use in areas vulnerable to coastal erosion
  • Making changes to community infrastructure, such as car parks or toilet blocks, so that the impact of coastal erosion on them is minimised
  • Looking into how funding can be secured for changes that will need to be made to adapt to a changing coastline
  • Working with the planning authority to ensure coastal change is taken into account
  • Working with businesses, community groups, as well as the wider public to help inform decisions.

Is there anything the funding can't be spent on?

The funding has been allocated to allow communities to adapt to change. It can be used in locations where the Shoreline Management Plan (SMP) policy is for Managed Realignment (MR). i.e. Summerleaze and Crooklets

The programme will not fund:

  • The building of any new flood defences
  • Any activity in areas where the Shoreline Management Plan policy is for ‘Hold the Line’ (HTL) i.e work to the breakwater
  • Activities that should take place as Business as Usual or routine maintenance
  • Any work to address damage caused by storm
  • Any work to undertake coastal clean up

What sort of thing might Future Coast Bude deliver?

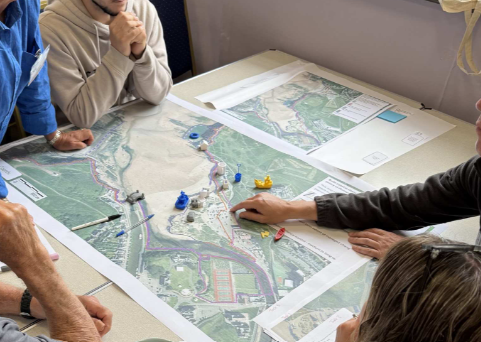

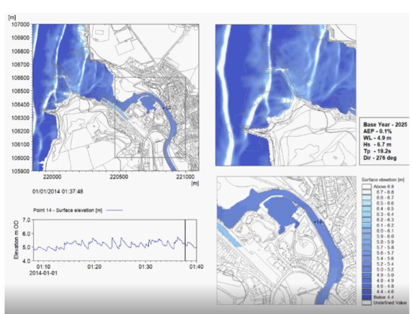

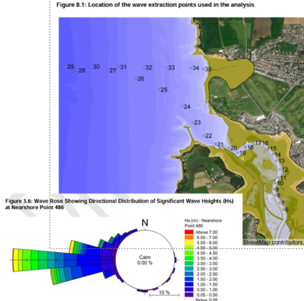

Future Coast Bude will explore with the community a plan for coastal change. This will include:

  • The development of a Coastal Change Management Plan (CCMP). This is designated through the Local Plan and is required where changes are expected to the coast in the next 100 years.
  • The introduction of a Coastal Change Management Area (CCMA) in areas not identified as ‘Hold the line’ in the Shoreline Management Plan. This can then be used to inform planning and management decisions in the future.
  • Undertaking a transport and accessibility study which will help to determine how and when people access the beaches and local areas in Bude and how this can be improved in the future.
  • Making plans for the future for infrastructure on the coast that may be impacted by sea level rise and coastal erosion.

Other opportunities that will be explored with the community include the potential:

  • Relocating of public facilities to alternative locations to make sure they can still be used by the public in the future
  • Relocating emergency services facilities, so that they can remain operational in the future
  • Designing facilities in the future in a way that will help them adapt and respond to climate change (for example the Gig Club has been designed so it can be relocated)
  • Decommissioning parts of the carpark which are currently covered by the dunes
  • Improving accessibility to and at the coast.

  • Bude Park and Ride Pilot - Frequently Asked Questions

    Share Bude Park and Ride Pilot - Frequently Asked Questions on Facebook Share Bude Park and Ride Pilot - Frequently Asked Questions on Twitter Share Bude Park and Ride Pilot - Frequently Asked Questions on Linkedin Email Bude Park and Ride Pilot - Frequently Asked Questions link

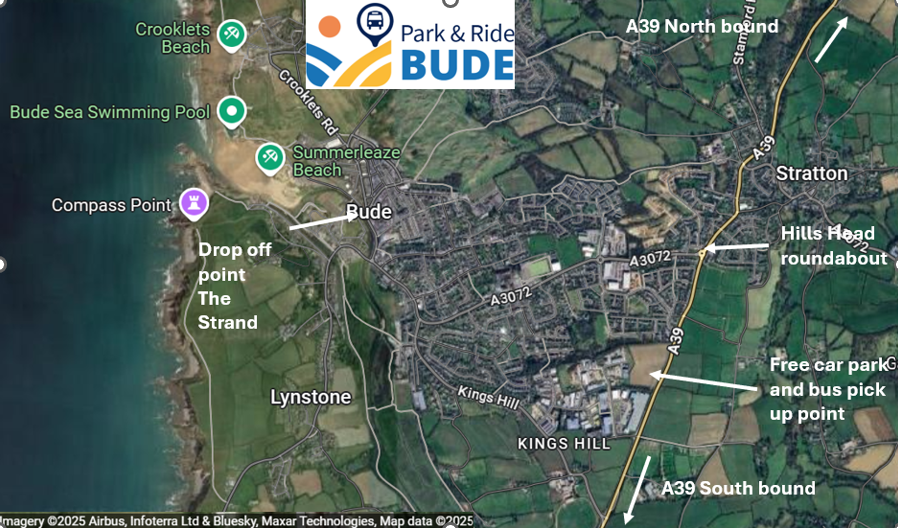

    Where is the Bude Park and Ride?

    The Bude Park and Ride is situated in the field between the Bude Business Park and the A39. It is accessed off the A39.

    How much is the Park and Ride?

    Adults are £2 return, children £1 return and a family of up to 2 adults and 4 children is £6. This compares to £10.50 for 24 hours car parking at Summerleaze car park.

    Park and Ride bus tickets will be specifically for the Park and Ride service and can't be used on any other GoCornwall Bus Service. Concessionary Bus Passes will not be accepted on this service.

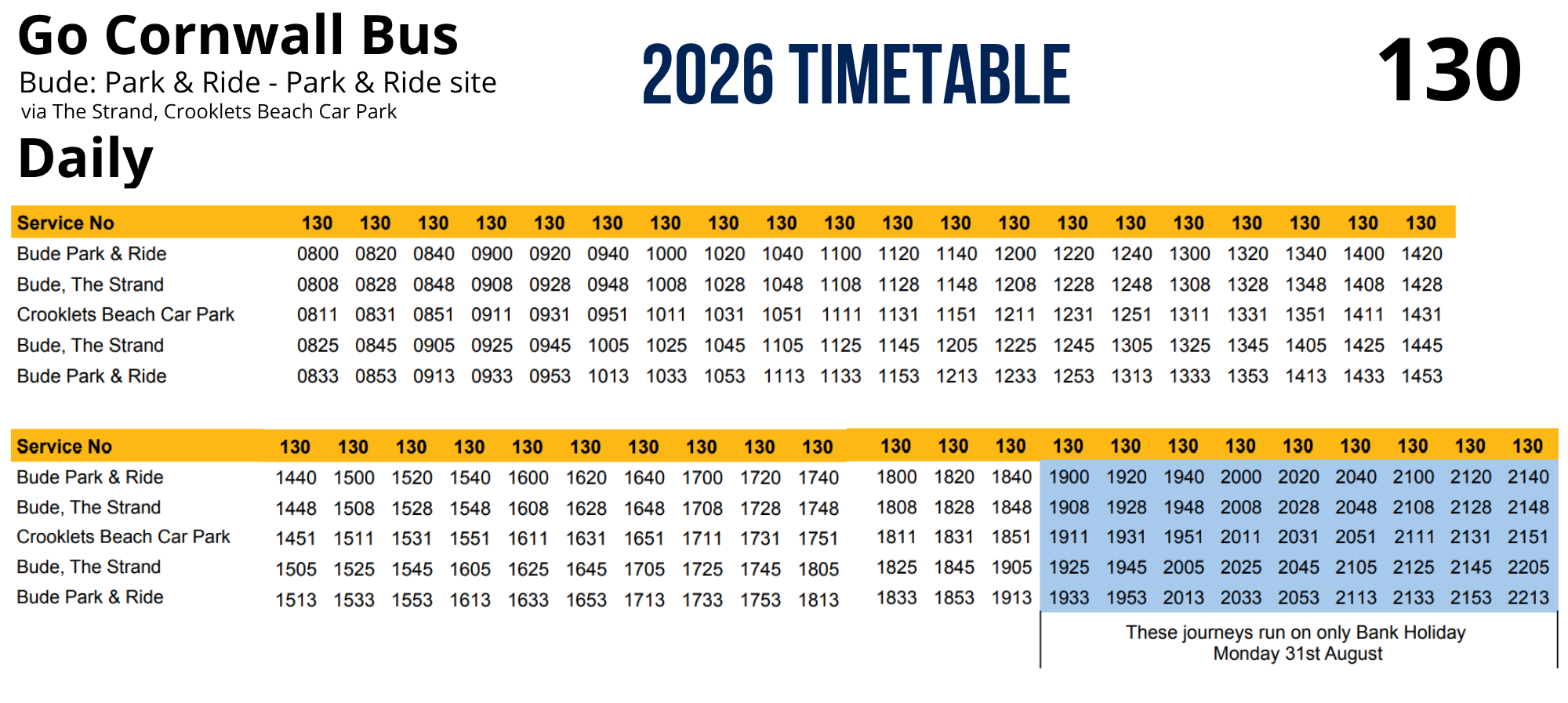

    What time is the service running?

    The first bus will depart the Park and Ride bus stop at 9:30. Buses will run every 15 minutes, departing the Park and Ride Site at quarter past, half past, quarter to and on the hour.

    The last bus to depart the Park and Ride will be at 18:45.

    The first bus will arrive at The Strand at 09:38. Buses will run every 15 minutes, departing The Strand at 12 minutes, 27 minutes, 42 minutes and 57 minutes past the hour.

    The last bus to depart The Strand is at 18:42.

    Can I take my beach equipment on the Park and Ride?

    You can take your beach equipment, although the buses will not be able to take large surf boards.

    How far is it to get to the beach from The Strand?

    Summerleaze beach is between 5 and 10 minutes walk and Crooklets beach is between 15 and 20 minutes walk.

    The Town Centre is around 3 minutes walk.

    Can dogs go on the Park and Ride?

    Dogs can travel free of charge on the Park and Ride.

    Is the Park and Ride suitable for wheelchair users?

    The parking field is quite uneven, and might be difficult to navigate in a wheelchair. The bus will have a ramp, but there is no kerb at the Park and Ride site, so the ramp will be quite steep if used.

    Whose land is the Park and Ride on?

    The Park and Ride field is being used by kind permission of the Dennis Family.

    What happens if I miss the last bus back to the Park and Ride?

    The Park and Ride is approximately 35 minute walk from The Strand. It is recommended that you access the Park and Ride field through the field entrance off the Bude Business Park.

    Local taxis may be able to take you.

    The gates to the site will be shut over night.

    Why are you piloting a Park and Ride in Bude?

    As our climate changes, our amenities on the coast will come under more and more pressure. This includes car parks. As part of a local consultation, a Park and Ride service for Bude was recommended to take the pressure off the beach side car parks. The Future Coast Bude project has provided the funding to pilot this to see if it helps provided a suitable alternative to town centre car parking.

  • Sand rails access work update - 17 July 2025

    Share Sand rails access work update - 17 July 2025 on Facebook Share Sand rails access work update - 17 July 2025 on Twitter Share Sand rails access work update - 17 July 2025 on Linkedin Email Sand rails access work update - 17 July 2025 link

    We previously said that the Sand Rails walkway would be ready in time for the summer holidays, and we are sorry that this won't now be the case.

    The contractors have been working hard to complete the project, carefully balancing the need for accessible beach access with the importance of preserving this historic part of Bude.

    Unfortunately, due to unexpectedly high spring tides at the beginning of the programme, challenges with the supply of concrete, and issues associated with the concrete setting quickly in hot weather, the work has been delayed.

    We understand this delay is disappointing, but it is important that the work is completed to a high standard - one that provides safe, long-lasting access for those with mobility needs, while protecting the integrity of the heritage structure.

    Cornwall Council are working with the contractors to explore all options available to mitigate the impact of any over-run on the local community and summer tourist season. It is hoped that an additional set of temporary steps will be installed, parallel to the existing steps, to help take the pressure off the main steps during peak season. We appreciate that this won't help if you aren't able to use the steps, and the contractors are working hard to compete this work as soon as possible. It is hoped that this will be by the end of the Summer holidays.

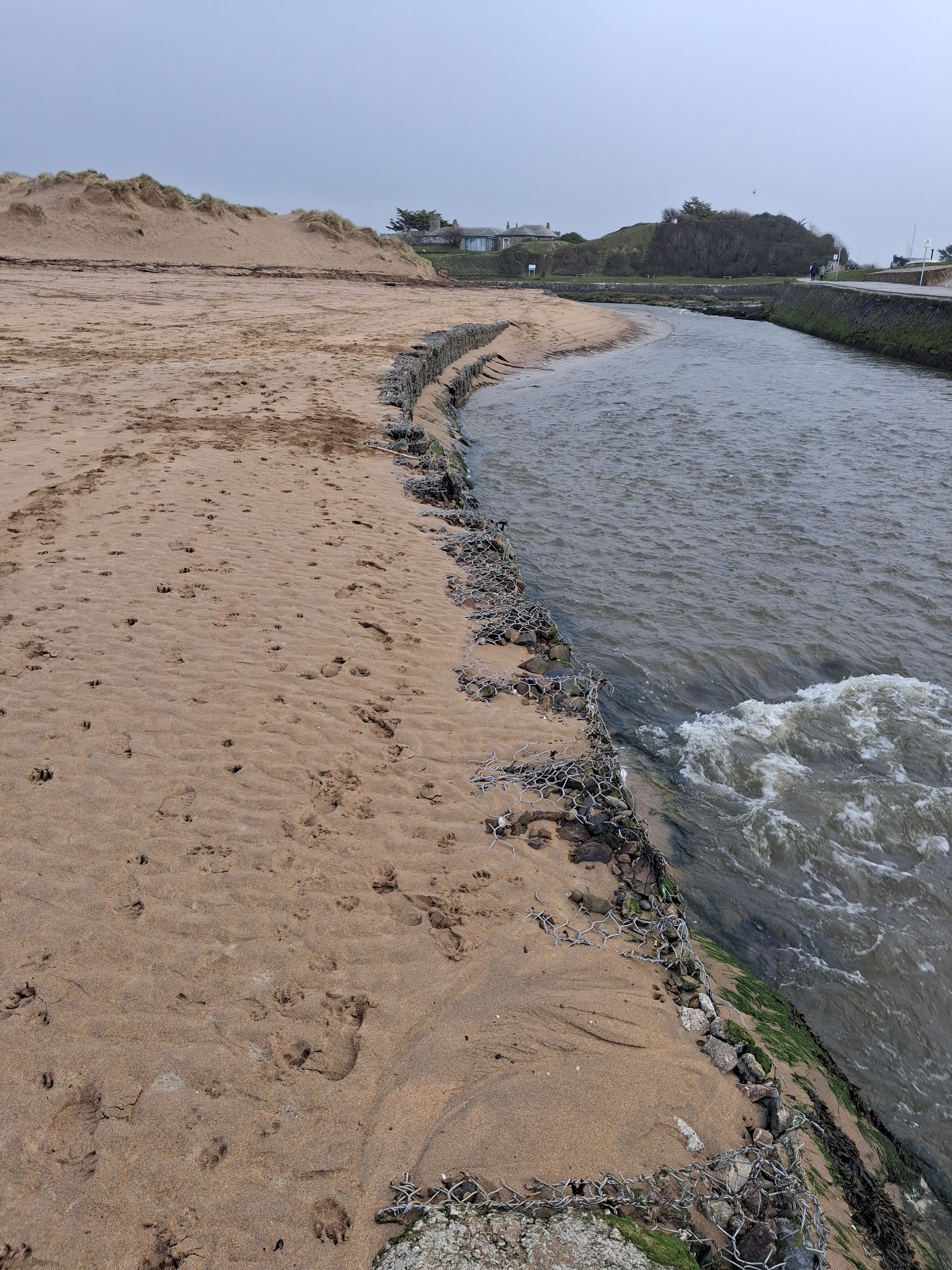

    Works continue on site with on the sloping revetment which has almost reached its full height. The dwarf wall is now complete, with the cobbled upper surface now being worked on.

    Three layers of scaffolding platforms installed for working
    on the revetment
    Cobblestones on top of dwarf wall looking seaward
    Dwarf wall and cobblestones looking landward

  • Bude Park and Ride Pilot Summer 2025

    Share Bude Park and Ride Pilot Summer 2025 on Facebook Share Bude Park and Ride Pilot Summer 2025 on Twitter Share Bude Park and Ride Pilot Summer 2025 on Linkedin Email Bude Park and Ride Pilot Summer 2025 link

    Future Coast Bude are delighted to announce that a Park and Ride will be trialled in Bude this summer, funded through the project.

    Reduce congestion, take the pressure off car parks, improve the environment in Bude and enjoy a stress free trip!

    The Park and Ride will start operating on Saturday 19 July 2025 and run until Saturday 30 August 2025, with buses running every 15 minutes from 09:30 to 19:00, 7 days a week.

    Free parking will be available in the field situated between Bude Business Park and the A39. The entrance and exit will be off the A39. People will be signposted along the footpath in the field that runs parallel to the A39, and comes out on the layby on the northbound carriage way.

    The bus will travel north along the A39, turn left at the roundabout and travel down the A3072 (Stratton Road), dropping off at The Strand, before returning to the Park and Ride via King’s Hill. Tickets will cost £2 return for adults, £1 return for children and £6 return for a family of up to 2 adults and 4 children.

    Park and Ride bus tickets will be specifically for the Park and Ride service and can't be used on any other GoCornwall Bus Service. Concessionary Bus Passes will not be accepted on this service.

    Signs will be put on the north bound carriage way before King’s Hill and the south bound carriage way before the roundabout encouraging people to use the park and ride. There will be signs either side of the field entrance, as well as signs in the car park telling people where to walk and information about the buses.

    The service number is Service 130.

    Dogs are allowed on the bus, and beach equipment. Small body boards will be accepted if there is room, however unfortunately there will not be capacity for surf boards.

    Background

    A Park and Ride was a key recommendation in the Town Vision, consulted on and delivered through the Town Team.

    The Town Vision stated, ‘By investing in improvement to Bude town centre’s public realm, transport options and connections, the negative impact of car congestion on the town centre can be reduced and more space can be used for initiatives that will grow a healthier, greener town centre that will adapt better to the challenges of climate change.’ Project 12 focussed on off-street parking and specifically mentions investing in a park and ride.

  • Sand Rails Access Work Update - 30 June 2025

    Share Sand Rails Access Work Update - 30 June 2025 on Facebook Share Sand Rails Access Work Update - 30 June 2025 on Twitter Share Sand Rails Access Work Update - 30 June 2025 on Linkedin Email Sand Rails Access Work Update - 30 June 2025 link

    Progress on the access way has been progressing well and another level of scaffolding has been installed to give access to higher up the revetment. This section of revetment has now been completed and pointed with Marine mortar. Progress has also been made on the dwarf wall.

    Second level of scaffolding Pointing of the wall. Progress on dwarf wall The rails have been painted with galvanised paint.
  • Future Coast Bude at the Bude & Stratton Heritage Festival

    Share Future Coast Bude at the Bude & Stratton Heritage Festival on Facebook Share Future Coast Bude at the Bude & Stratton Heritage Festival on Twitter Share Future Coast Bude at the Bude & Stratton Heritage Festival on Linkedin Email Future Coast Bude at the Bude & Stratton Heritage Festival link

    Future Coast Bude will be taking part in the upcoming Bude & Stratton Heritage Festival on Sunday 13 July. Led by Cornwall Council, in partnership with the Environment Agency and supported by a range of local and regional organisations including Bude-Stratton Town Council, the project is focused on helping Bude prepare for future coastal change.

    At the festival, the Future Coast Bude team will be inviting local people to share their memories, knowledge, and stories about Bude’s coastline. If you have old photos, postcards, paintings or simply memories of how the coast has changed over the years, the team would love to hear from you. Your contributions will help build a visual, community-led timeline of the coast — from the past to the present — forming part of an interactive coastal map on the day.

    This early engagement is a key part of building the project around local insight, priorities and lived experience.

    What is Future Coast Bude?
    Future Coast Bude is a new project focused on preparing for coastal change and supporting improvements to public facilities. It is funded through the national Coastal Transition Accelerator Programme (CTAP) and will run from April 2025 to March 2027.

    Rather than focusing solely on risks, Future Coast Bude is about supporting climate resilience — enhancing our coastal spaces to ensure Bude remains a thriving and welcoming place for generations to come. The project will build on local priorities and deliver practical improvements to support a more accessible, climate-resilient coastline for everyone who lives in, works in, or visits Bude.

    What’s coming up?
    The team will also be providing updates and information at the festival on several related areas of work:

    • The Sand Rails project progress.
    • Sand management at Summerleaze Car Park, where sand build-up has affected parking and raised understandable concerns in the community. Future Coast Bude provides an opportunity to look again at the current approach. We're in the process of setting up conversations with key organisations, and we’re keen to listen to those most affected. While we can’t promise immediate solutions, this is a chance to start a more joined-up discussion about the challenges and explore potential options together. We’ll share further updates as this work develops.
    • Early conversations to help shape the area’s Coastal Vision.

    What is the Coastal Vision?
    The Coastal Vision is about working with the local community to shape a shared idea for the future of Bude’s coastline. It’s a chance to think about what matters most to people — from how we use and enjoy the coast, to what we want it to look and feel like for future generations. It will help guide decision-making across the project.

    What is the Coastal Change Management Plan?
    The Coastal Change Management Plan is a more detailed document that sets out how we respond to the challenges of coastal change — such as erosion, rising sea levels and more extreme weather. It looks at the practical steps we can take to adapt access, support local people and businesses, and make the coast more resilient over time.

    Importantly, it will also help guide future planning decisions by providing clear information about the risks and opportunities linked to coastal change in Bude.

    This work will rely heavily on community involvement — not just to shape ideas, but to ensure local needs, voices and knowledge are reflected in how we move forward.

    We encourage everyone to come along to the festival, meet the team and get involved in this important early stage of the project.

  • Sand Rails Access Work Update - 23 June 2025

    Share Sand Rails Access Work Update - 23 June 2025 on Facebook Share Sand Rails Access Work Update - 23 June 2025 on Twitter Share Sand Rails Access Work Update - 23 June 2025 on Linkedin Email Sand Rails Access Work Update - 23 June 2025 link
    supporting image

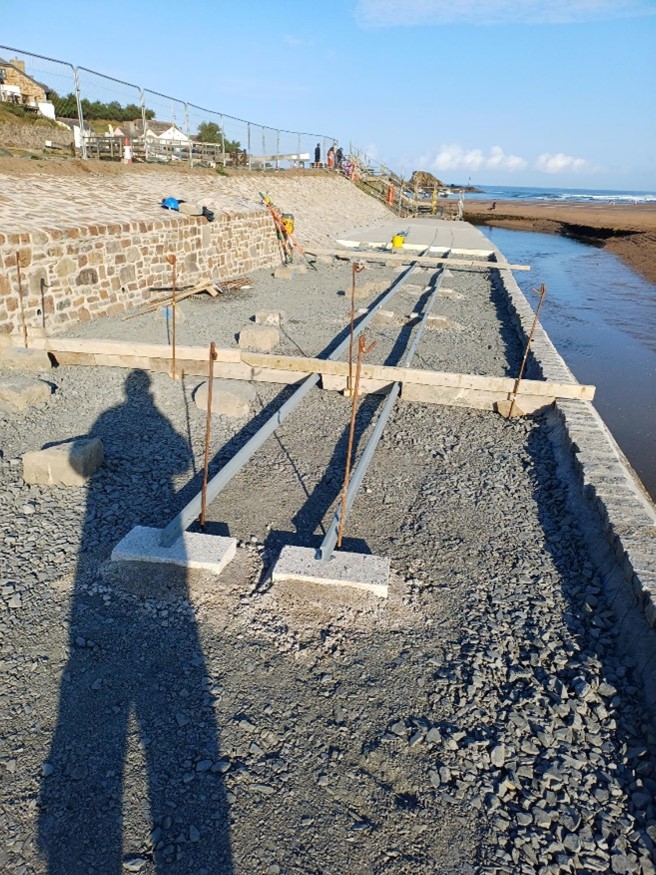

    Progress continues on site as work moves into the next phase. Materials are being prepared, key features are taking shape, and the team is making use of specialist techniques to support the restoration.

    Take a look at this week’s images for a snapshot of what’s happening.

    Stone from Pigsdon Quarry is being mixed with
    the existing stones to ensure enough stones are available for the work.

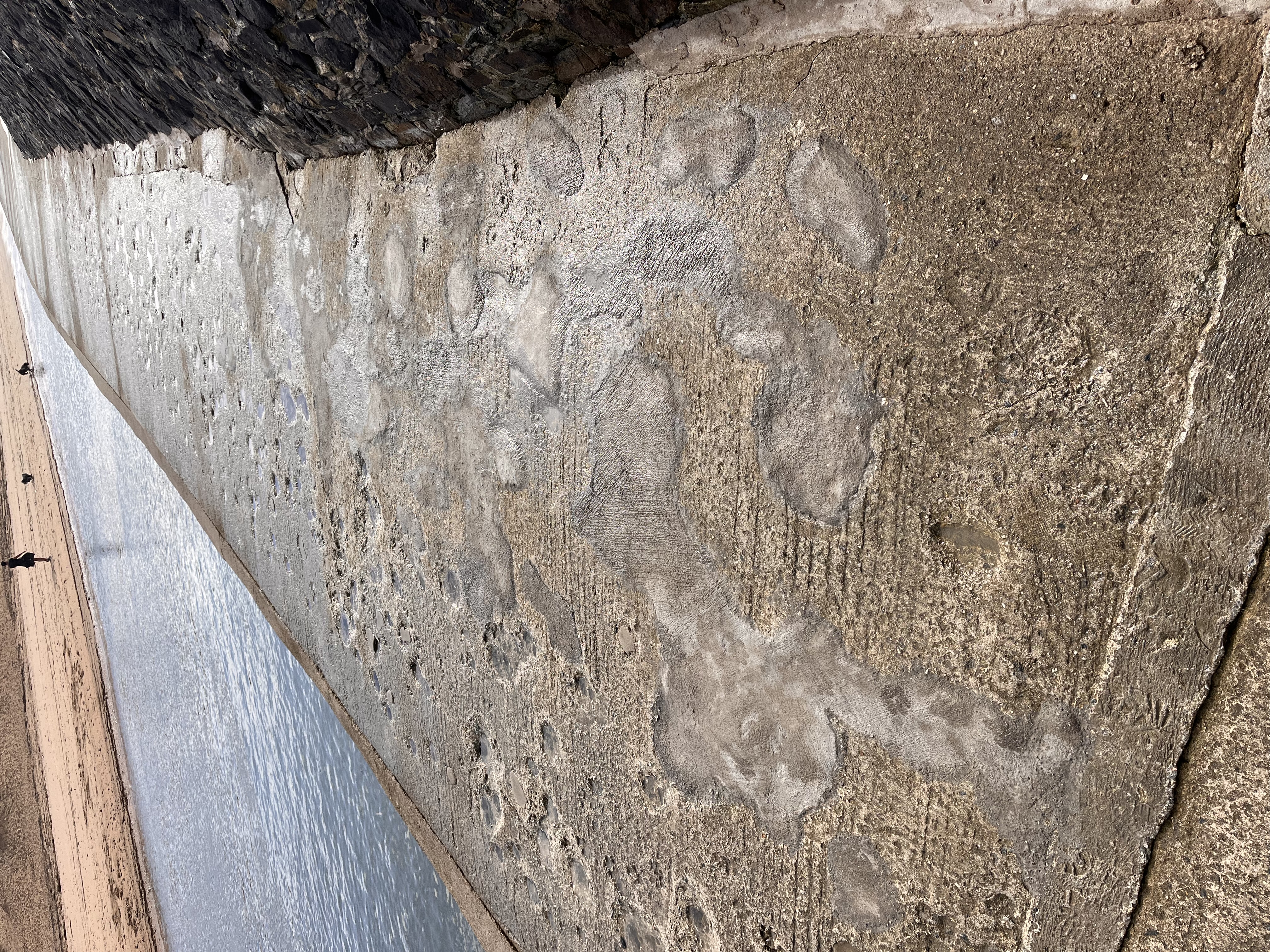

    A temporary scaffolding deck has been installed to give access further up the revetment.

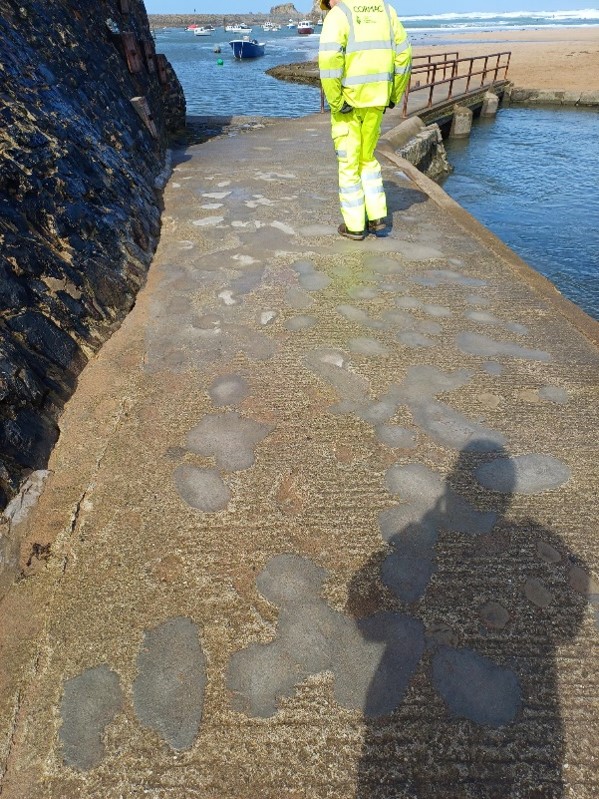

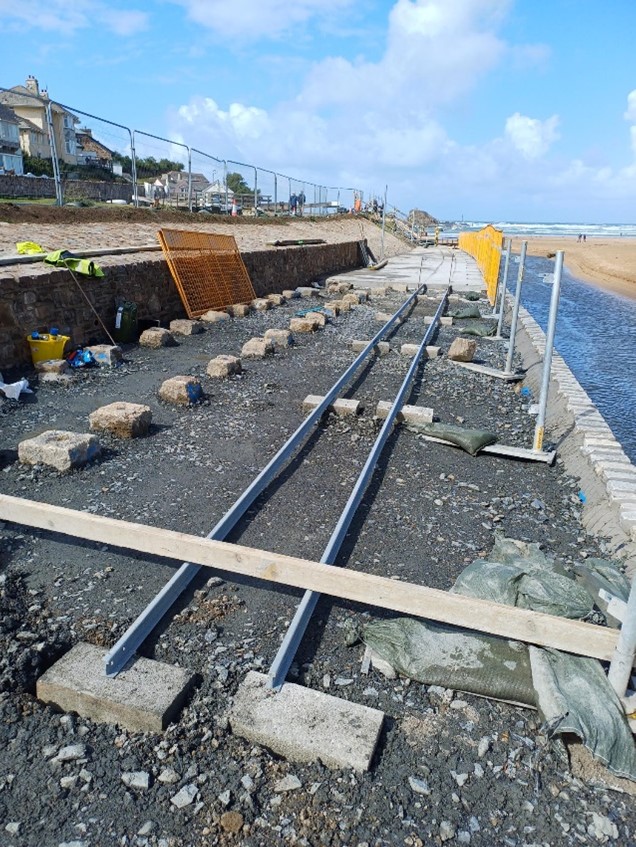

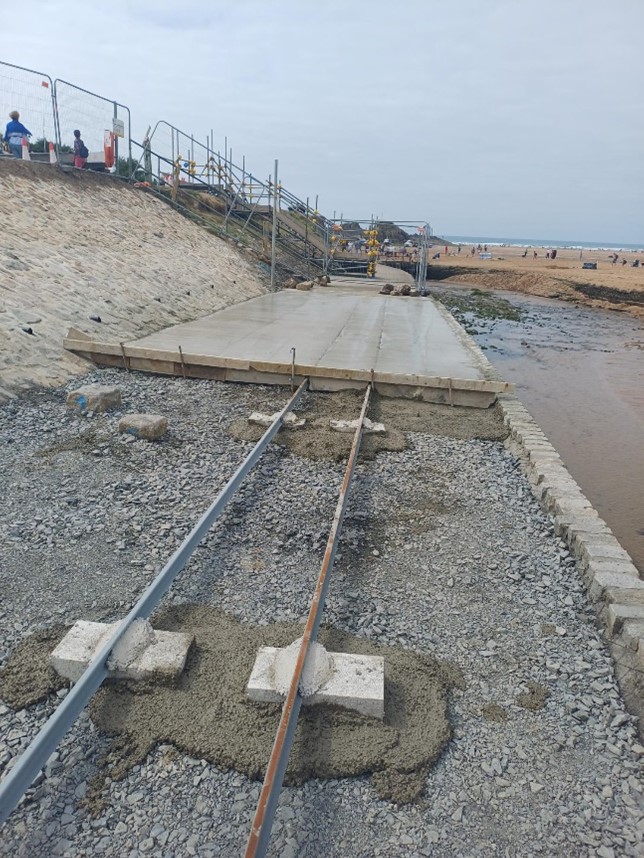

    The revetment section has been completed and is being pointed in Marine mortar. Setting out for the ‘dwarf wall’ has been completed.
    The replacement “sand rails” have been delivered, for use where the existing ones are in poor condition. These have been painted with a special paint to help preserve them.

  • Sand Rails Access Work Update - 16 June 2025

    Share Sand Rails Access Work Update - 16 June 2025 on Facebook Share Sand Rails Access Work Update - 16 June 2025 on Twitter Share Sand Rails Access Work Update - 16 June 2025 on Linkedin Email Sand Rails Access Work Update - 16 June 2025 link
    supporting image

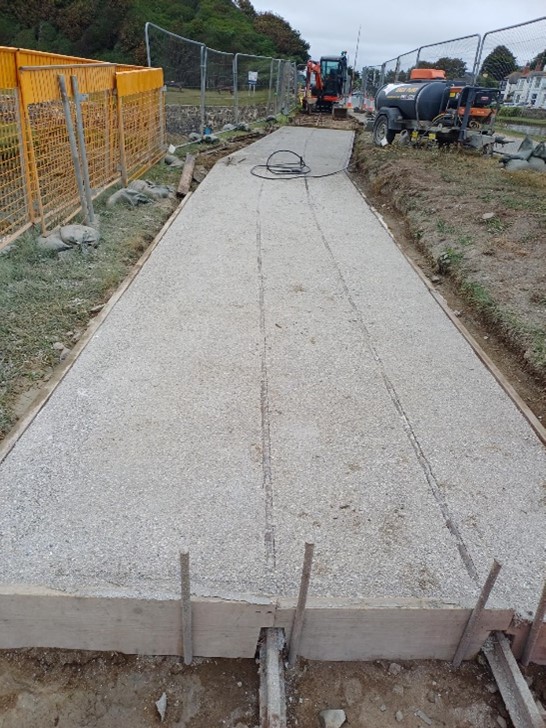

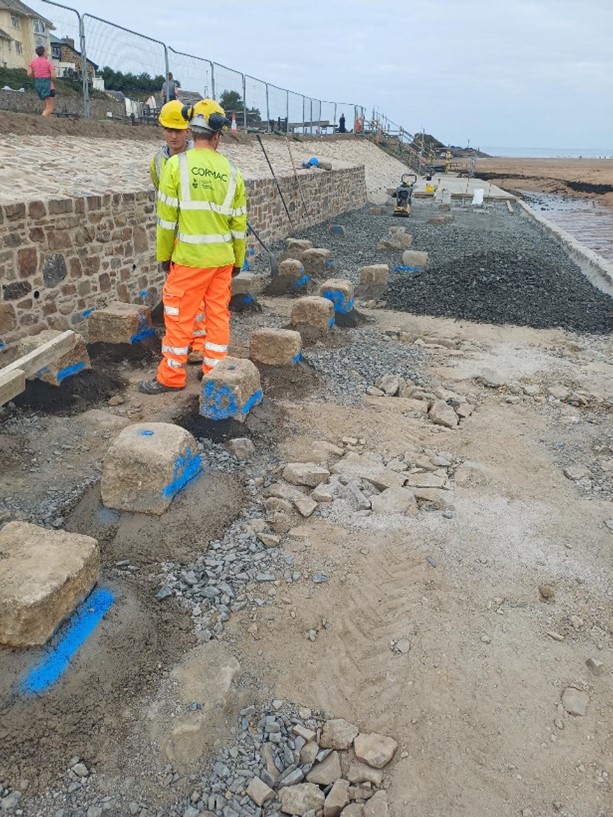

    Works on site are progressing, with further courses of reclaimed blockwork being added to the sloping revetment. Due to the linear nature of the site and to reduce manual handling, the revetment is being built up in layers from the seaward end first.

    The works for the next week involve:

    • Continued rebuilding of the revetment
    • The addition of scaffolding to aid access to the working areas
    • Rebuilding works planned for the short retaining wall.
    • Replacement rails are expected to be delivered and will require the application of a corrosion resistant paint in order to extend their lifespan before their eventual installation.
    Excavated revetment material being sorted for reuse to rebuild wall.
    Further courses of block work being added to the sloping revetment.
    Removal of old retaining wall and fresh foundation ready.
  • Sand Rails Access Work Update - 9 June 2025

    Share Sand Rails Access Work Update - 9 June 2025 on Facebook Share Sand Rails Access Work Update - 9 June 2025 on Twitter Share Sand Rails Access Work Update - 9 June 2025 on Linkedin Email Sand Rails Access Work Update - 9 June 2025 link
    supporting image

    Works on the revetment have been progressing well despite high tides preventing works on the lower revetment at times.

    Removal of old revetment material.
    Providing a new foundation and level guides for the new revetment surface.

    Completed lower section of revetment including drainage.

    Further up the walkway the small retaining wall between the walkway and the canal has been dismantled. This is now scheduled for reconstruction with a new concrete foundation to ensure its future stability.
  • Sand Rails Access Work Update - 2 June 2025

    Share Sand Rails Access Work Update - 2 June 2025 on Facebook Share Sand Rails Access Work Update - 2 June 2025 on Twitter Share Sand Rails Access Work Update - 2 June 2025 on Linkedin Email Sand Rails Access Work Update - 2 June 2025 link
    supporting image

    Cormac have been continuing to work on the sand tram way sloping revetment by dismantling the old structure and re-building the revetment with a concrete foundation. They are also providing drainage to the structure - something that the original revetment lacked.

    The old revetment blockwork has been removed and sorted, with the intention to re-use as much of the original blockwork as possible.

    After weeks of good weather, the recent change in weather has proved challenging. Recent high tides have also prevented work on the lower section of the revetment at times. However, works have proceeded elsewhere on site.

    The next week's work will focus on the rebuilding of the short wall next to the siding higher up the revetment, whilst waiting for the delivery of the tramway replacement rails.

  • Sand Rails Walkway – Why the Work Was Needed

    Share Sand Rails Walkway – Why the Work Was Needed on Facebook Share Sand Rails Walkway – Why the Work Was Needed on Twitter Share Sand Rails Walkway – Why the Work Was Needed on Linkedin Email Sand Rails Walkway – Why the Work Was Needed link
    supporting image

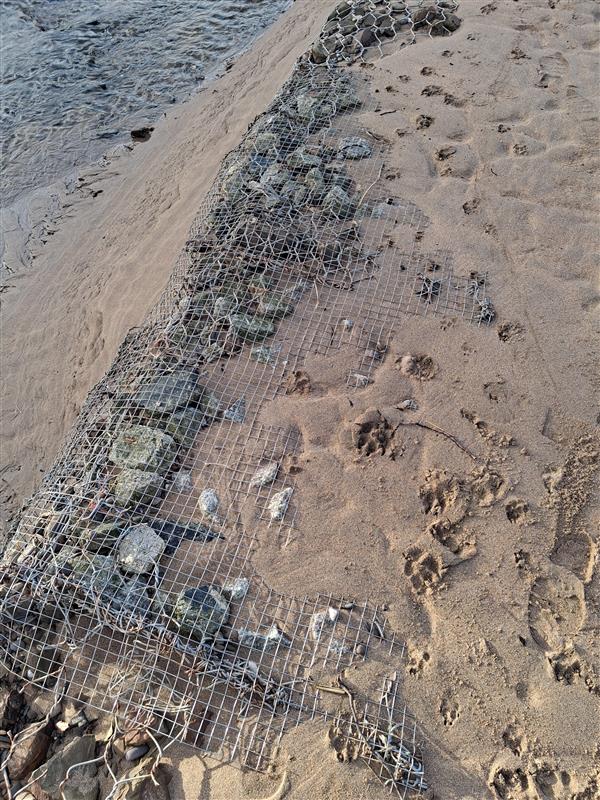

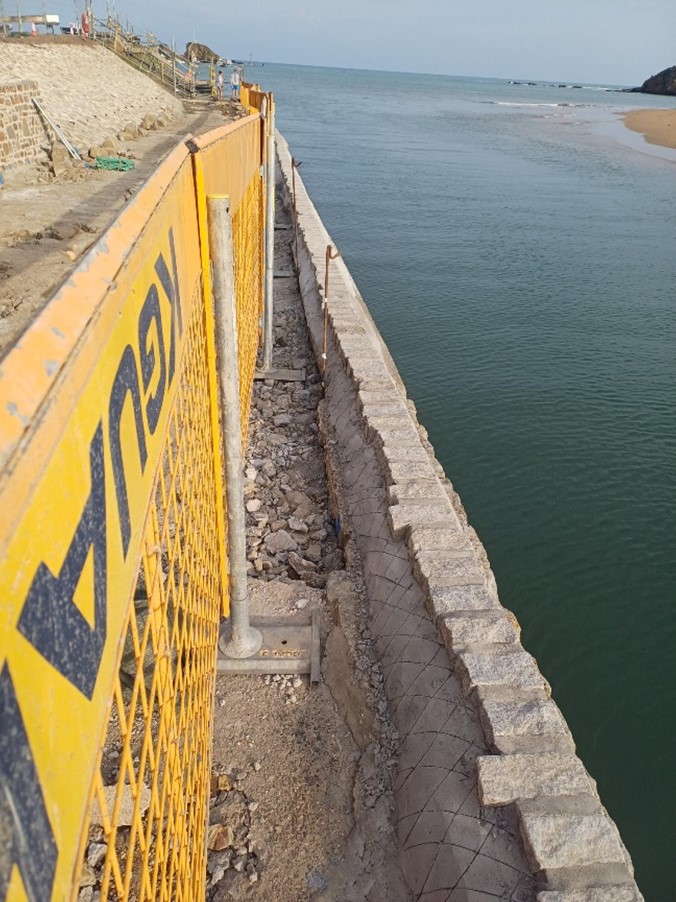

    In May 2023, the lower section of the sand railway walkway near Summerleaze was closed on public safety grounds due to significant erosion caused by wave action. Inspections revealed two main issues:

    • The canal wall between the walkway and the river had been weakened by wave damage, including the loss of mortar and the formation of voids (holes).
    • The walkway surface itself had become uneven and unsafe, particularly for those using wheelchairs, pushchairs or with limited mobility.

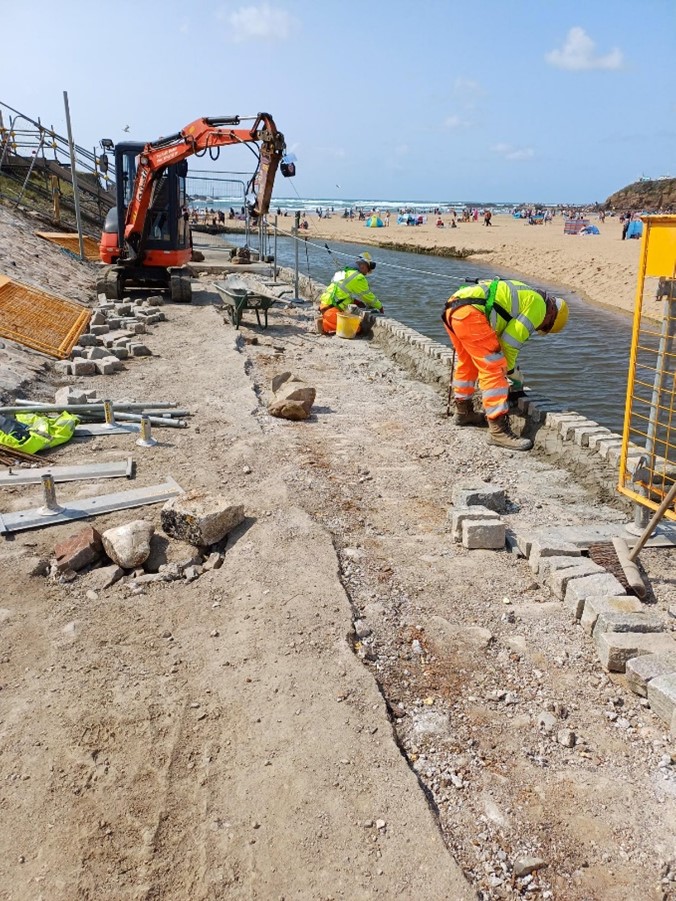

    Early in 2025, Cornwall Council commissioned essential repair works to stabilise the canal embankment. This included filling identified voids and repointing missing mortar along the sea wall. These initial repairs were funded through Cornwall Council’s capital maintenance budget.

    What Happens Next?

    Further improvement works to the walkway are now part of Future Coast Bude, supported by funding from Defra as part of the Coastal Transition Accelerator Programme (CTAP). Future Coast Bude is one of several projects across England being delivered under the £200 million Flood and Coastal Innovation Programme, managed by the Environment Agency.

    The additional funding will allow:

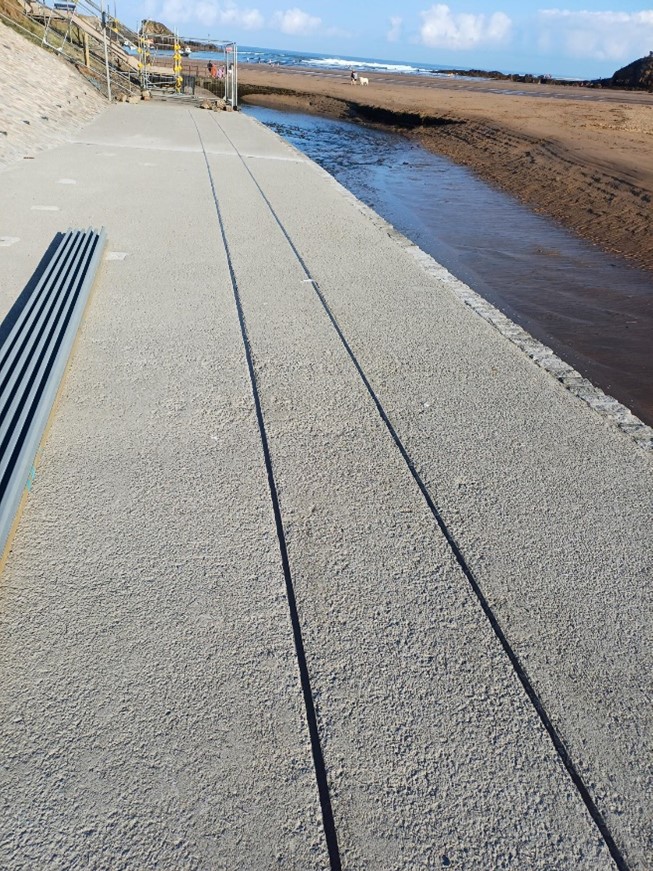

    • Resurfacing of the walkway to provide safer and more accessible access to the beach
    • Preservation of key historic features where possible
    • A broader review of land use along the beachfront at Crooklets and Summerleaze in light of future coastal change

    Work to resurface the walkway is being carried out by Cormac, with completion expected before the 2025 summer holidays.

    If you have any questions about this work, please contact: futurecoastbude@cornwall.gov.uk
