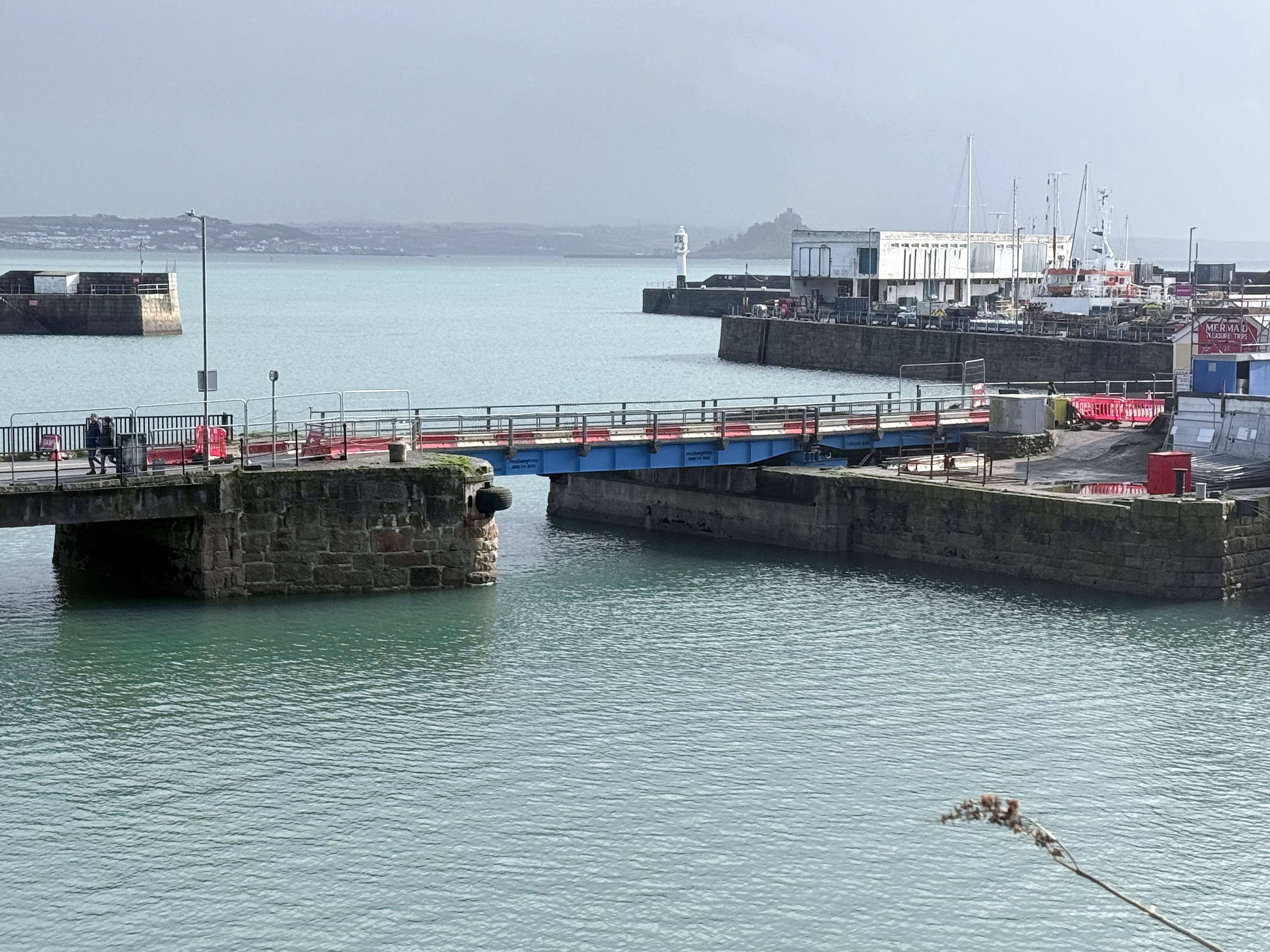

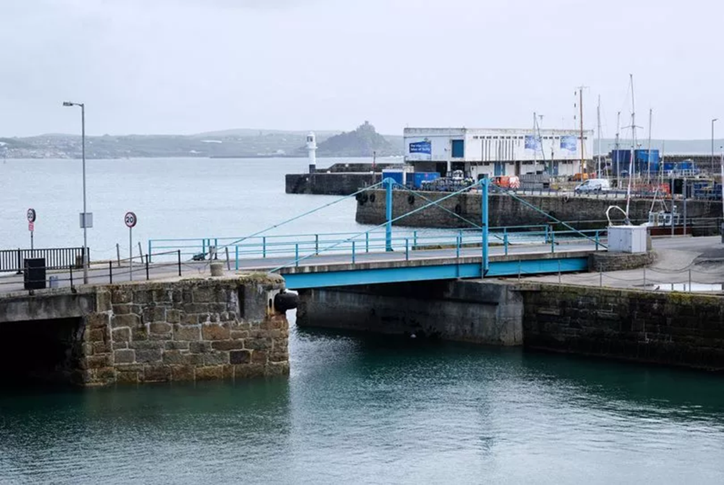

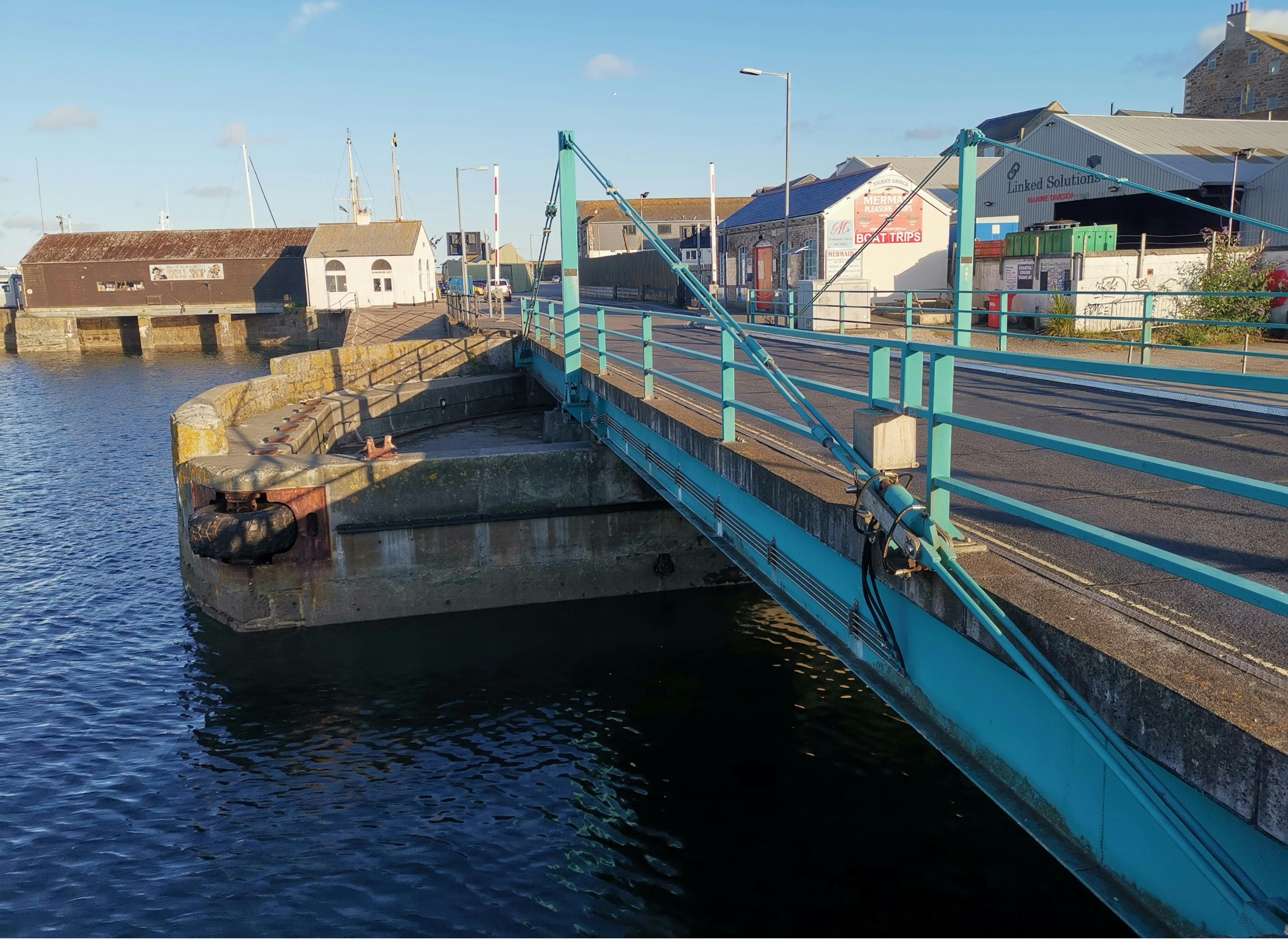

Ross Swing Bridge refurbishment, Penzance commencing 5th January 2026 for thirteen weeks

Share Ross Swing Bridge refurbishment, Penzance commencing 5th January 2026 for thirteen weeks on Facebook Share Ross Swing Bridge refurbishment, Penzance commencing 5th January 2026 for thirteen weeks on Twitter Share Ross Swing Bridge refurbishment, Penzance commencing 5th January 2026 for thirteen weeks on Linkedin Email Ross Swing Bridge refurbishment, Penzance commencing 5th January 2026 for thirteen weeks link

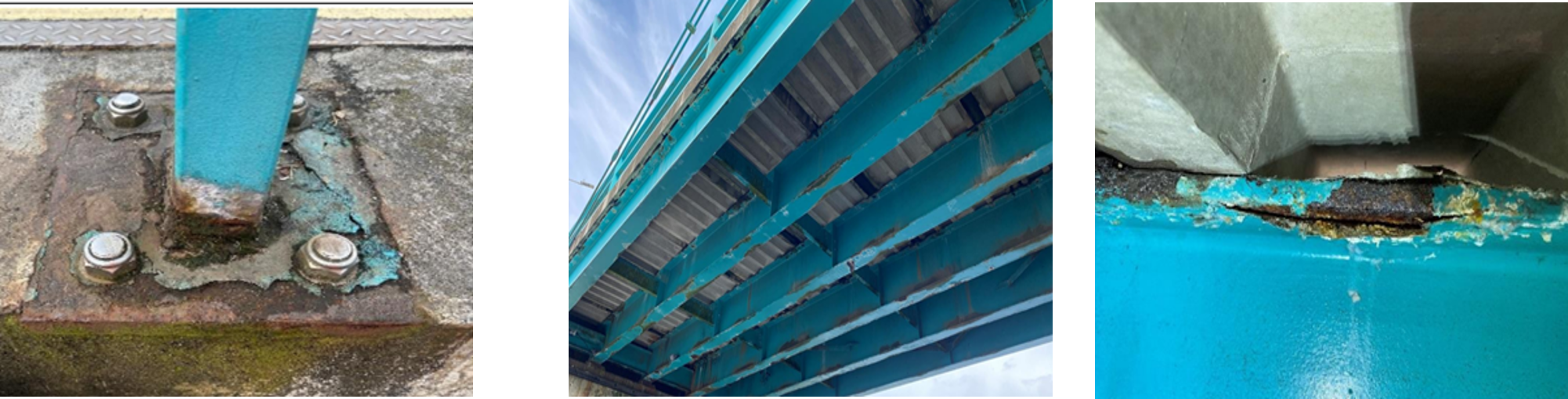

In September 2024 a Principal Inspection of the bridge was carried out, which revealed that areas of the steel-work required repair and repainting. Although some areas were in better condition than others, it was determined that the entire steel-work on the structure must be refurbished.

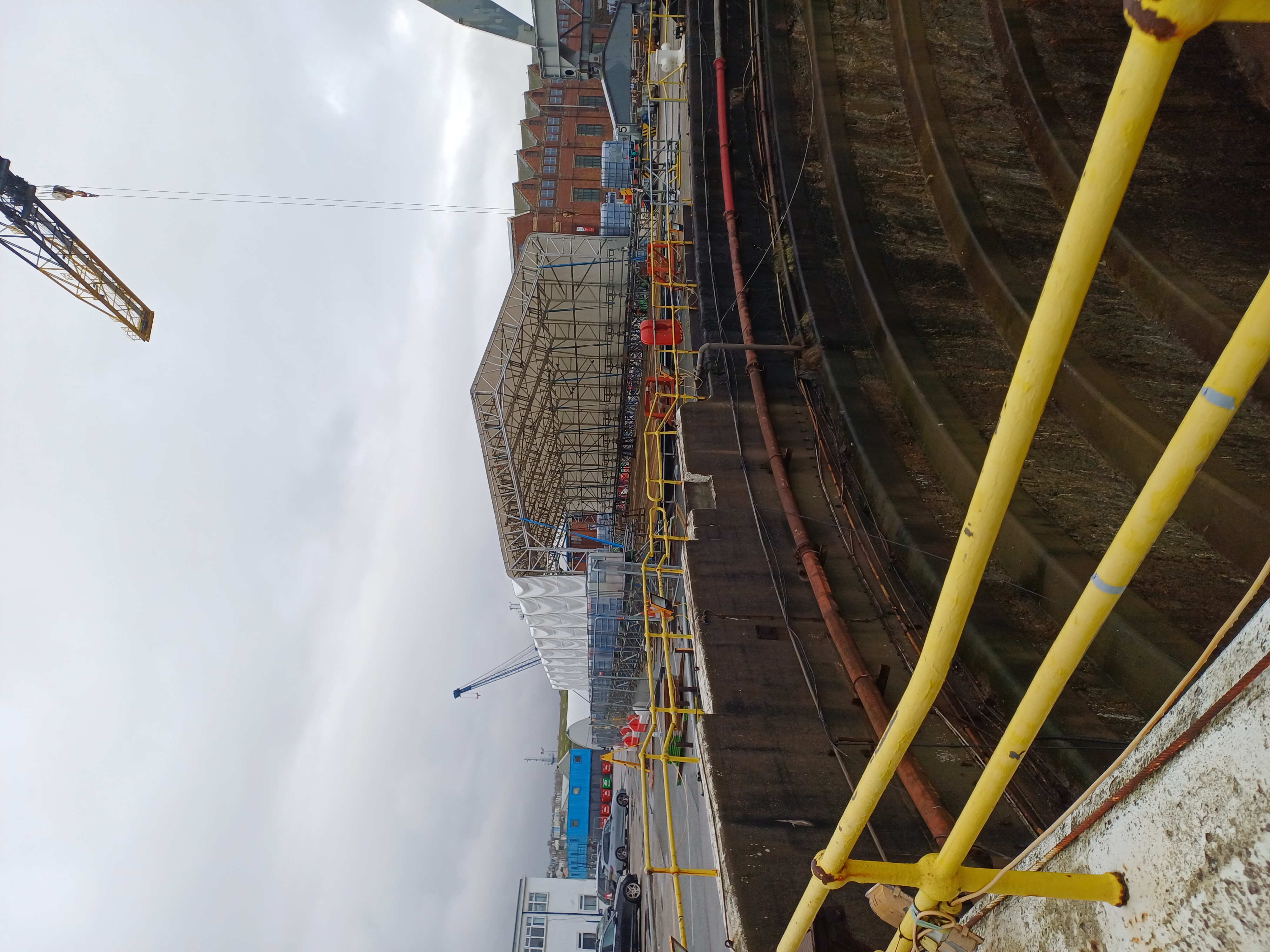

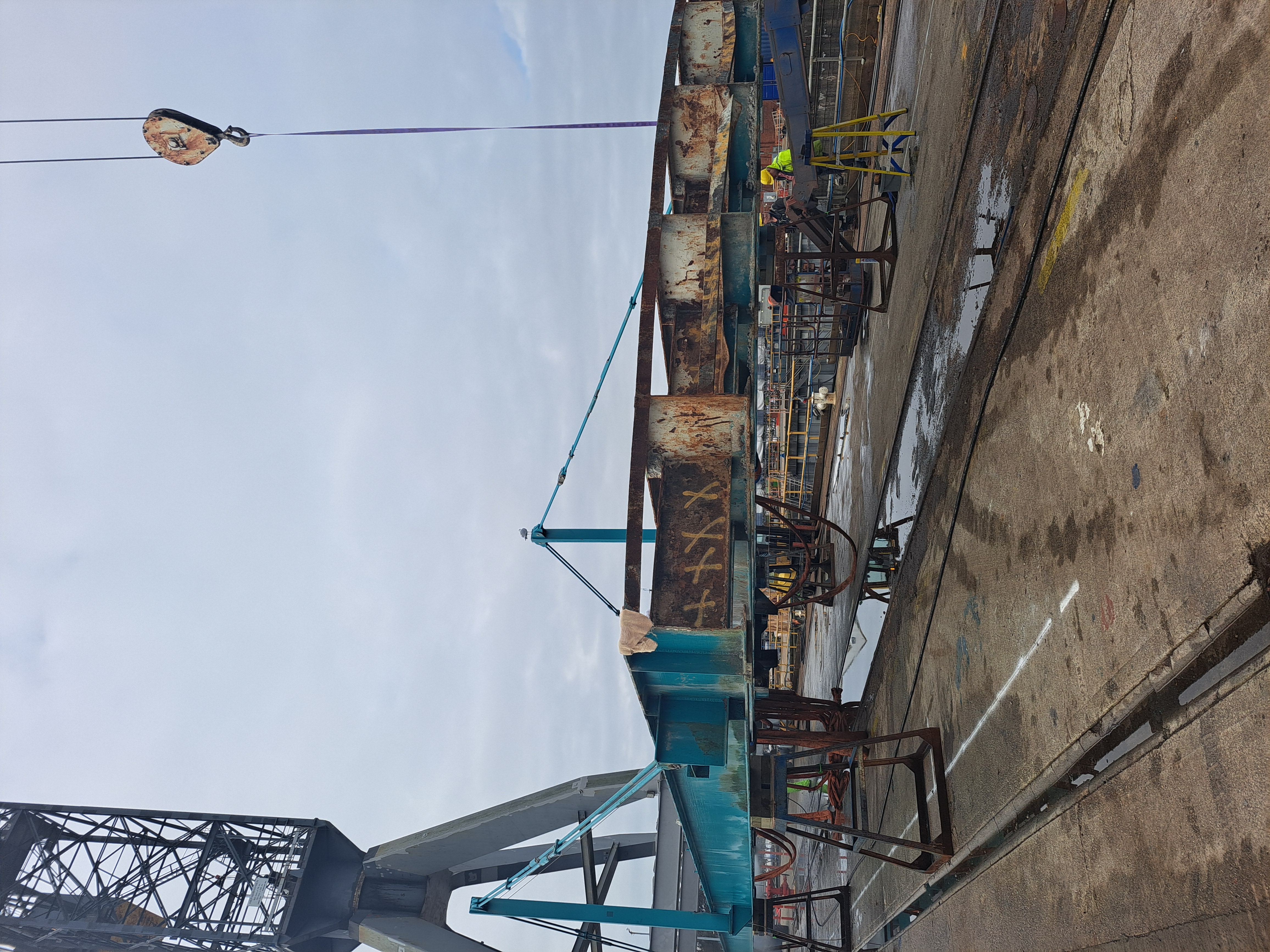

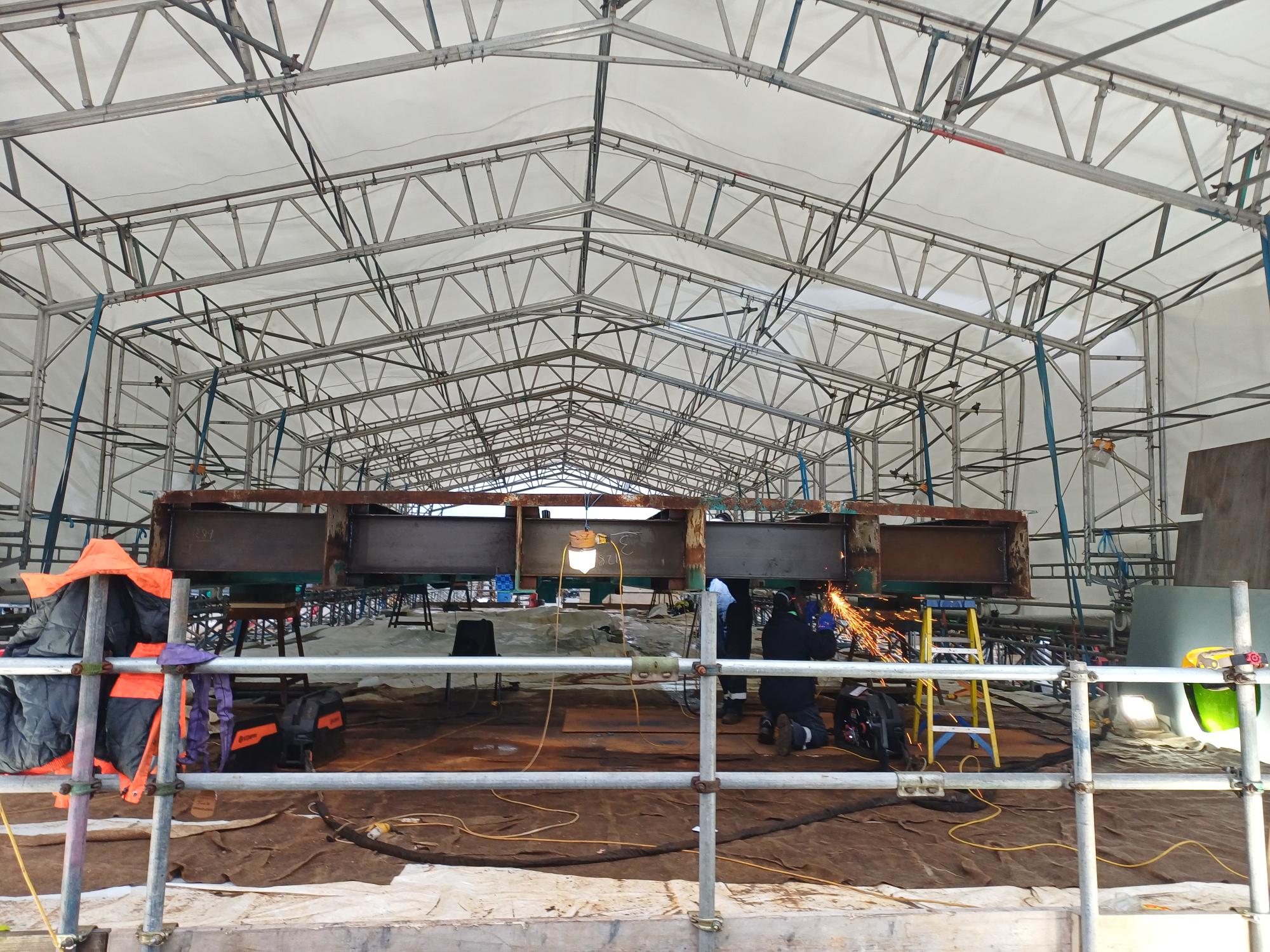

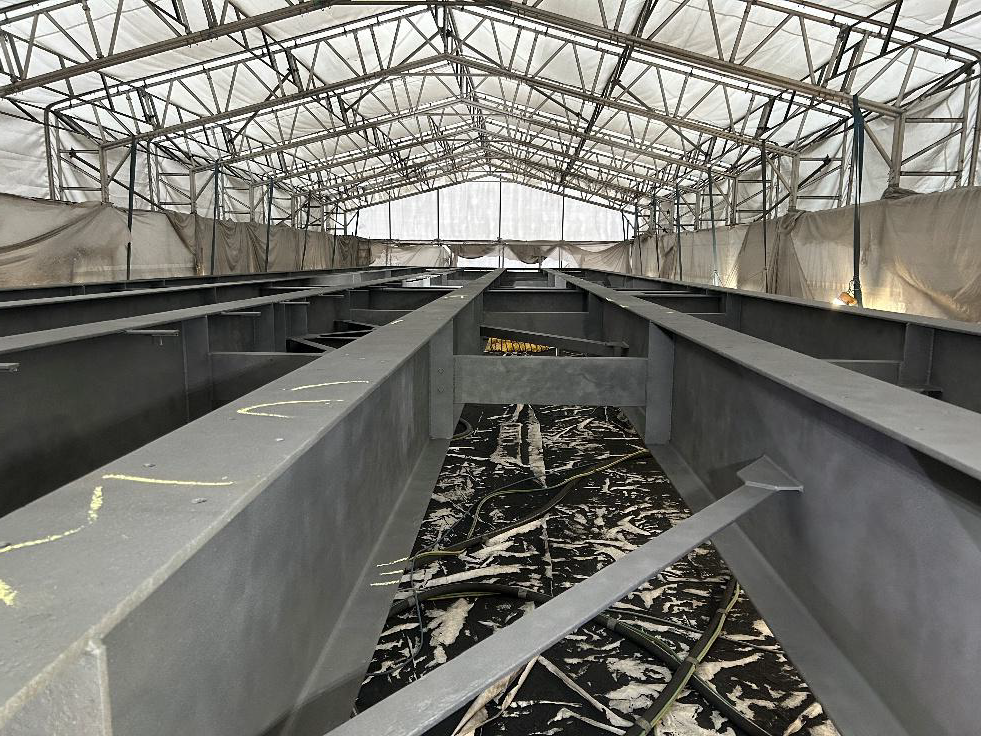

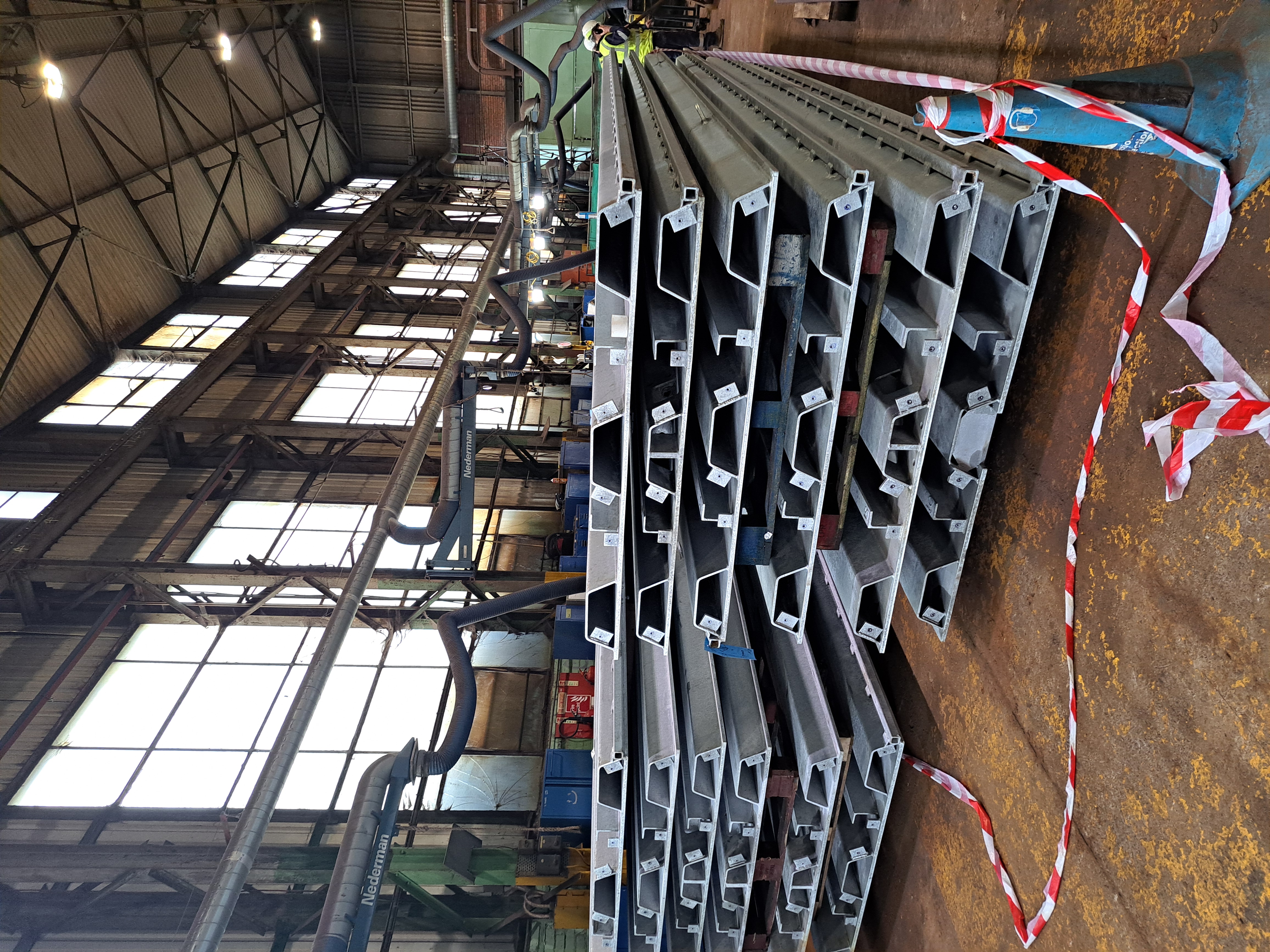

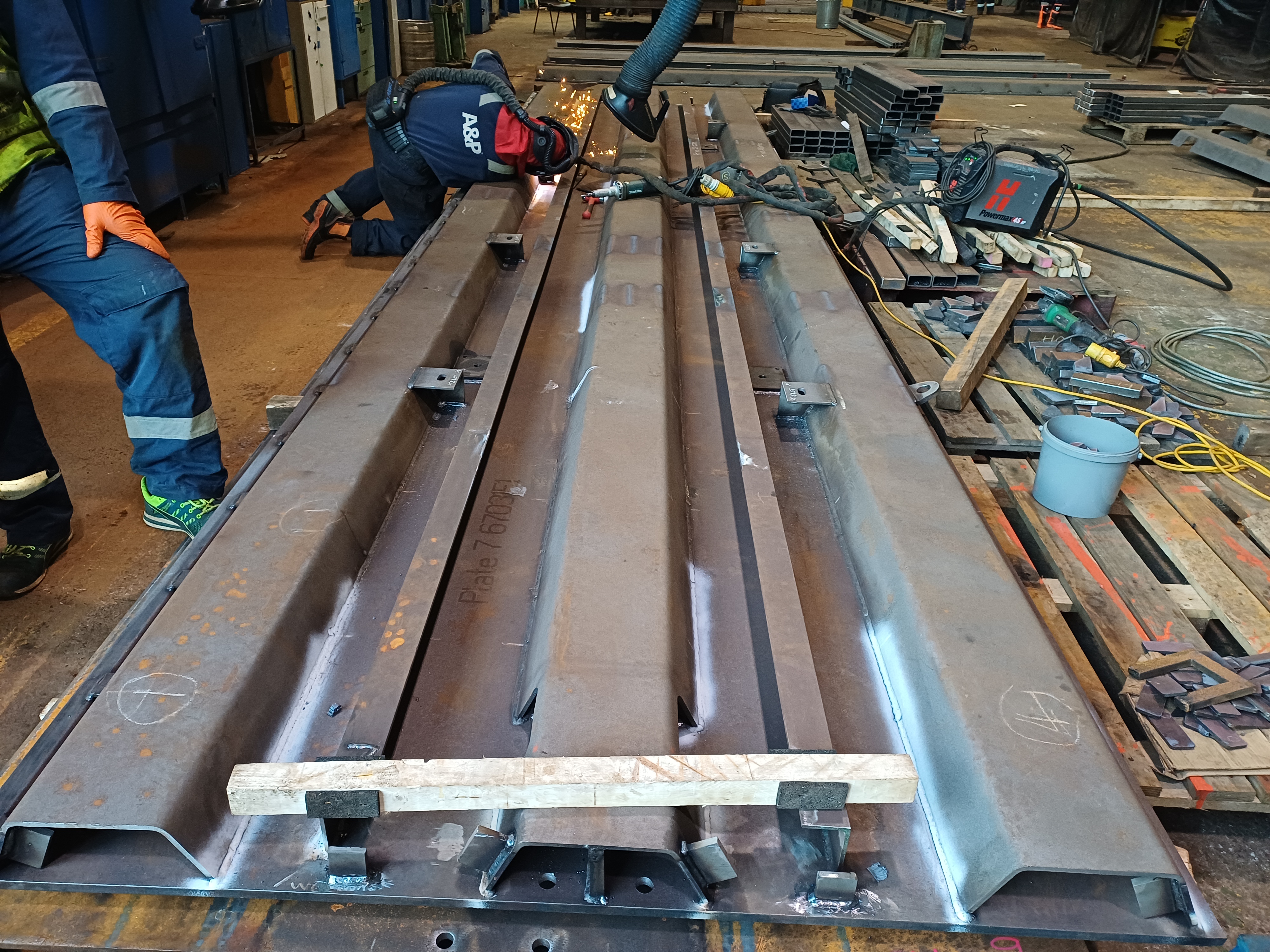

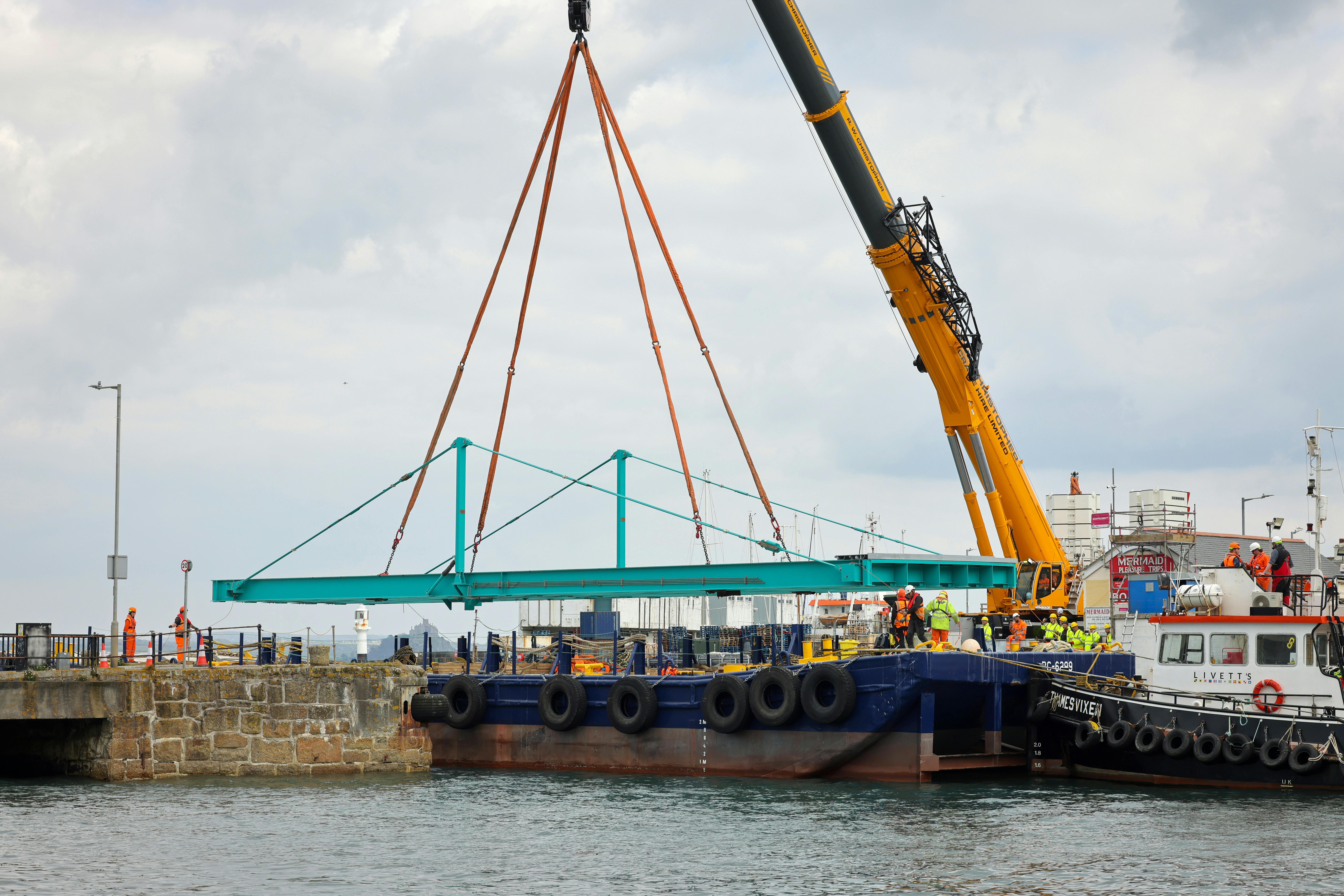

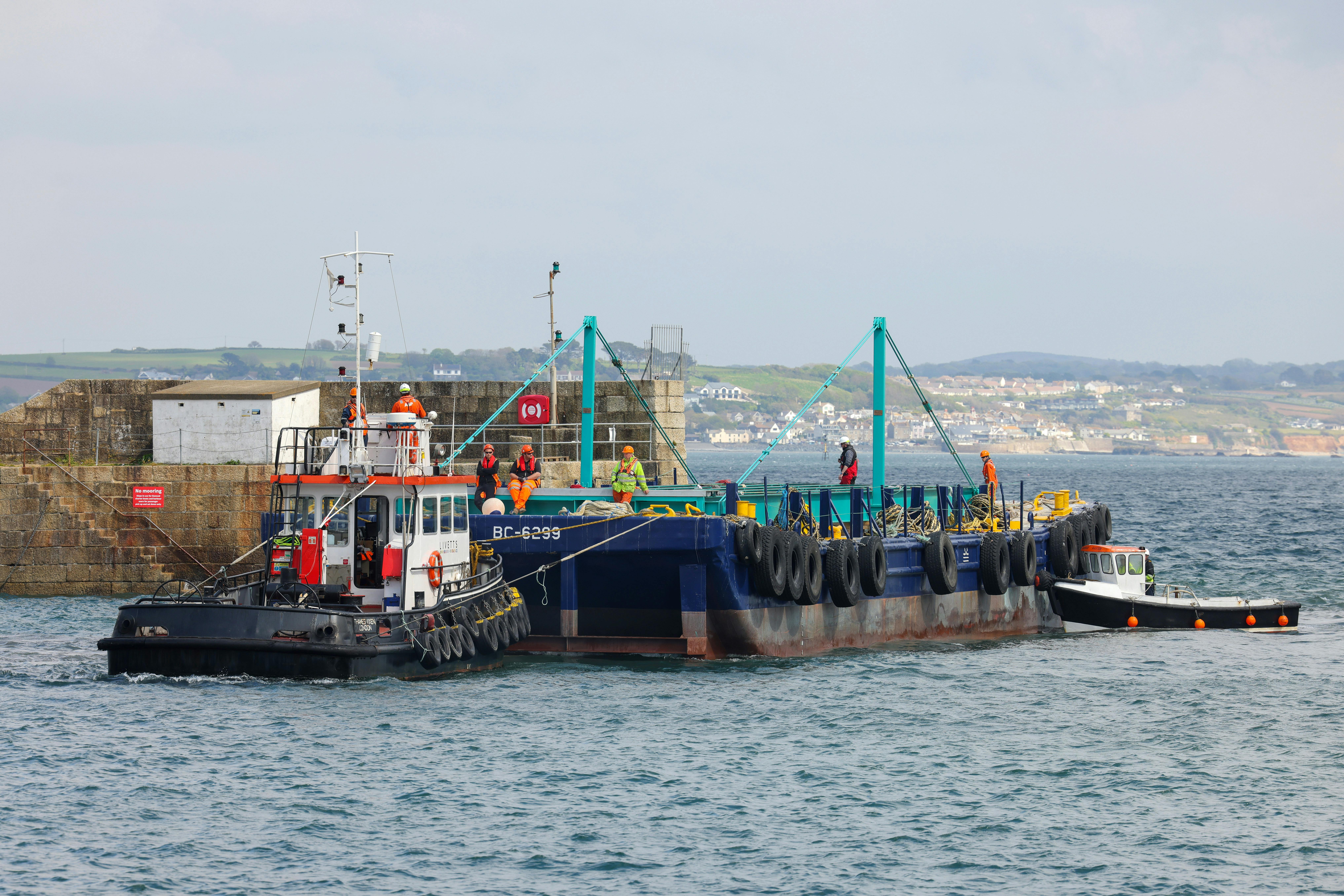

The bridge will be dismantled and the existing concrete deck removed for recycling. The steel-work structure will be lifted on to a barge using a crane, then transported by sea to a dry dock facility at Falmouth, for specialist refurbishment. This will include inspection and maintenance of the hydraulic mechanisms which are used to shift lift and rotate the bridge in and out of position, shot blasting, refurbishment and repainting of the steel structure, masts, and stays, and new steel parapets and a new footway will be fabricated. The structure will then be transported back to Penzance, to be assembled and lifted back in to place, before resurfacing and the reinstatement of the pedestrian footway.

Keeping Penzance Moving - Road Closures

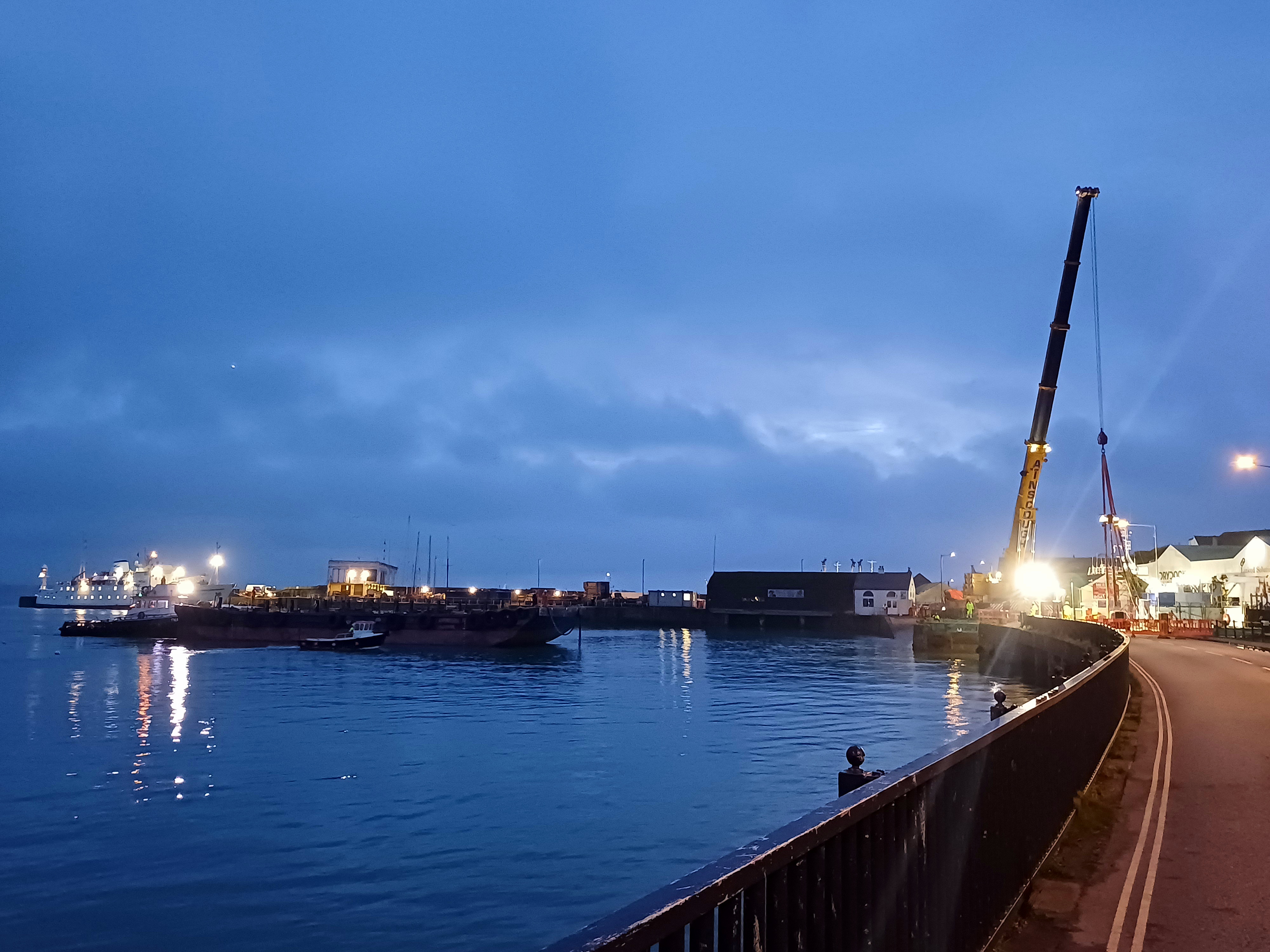

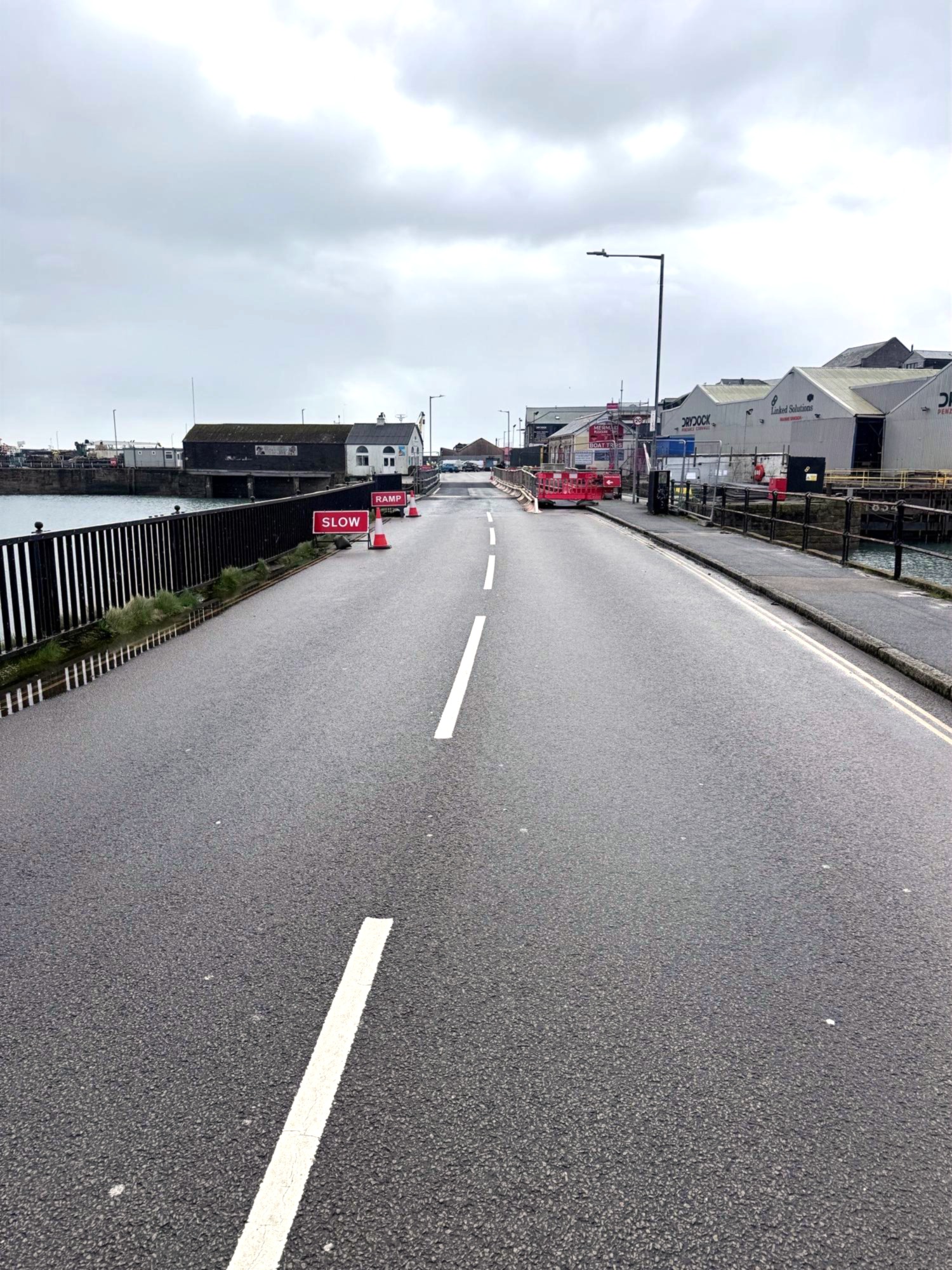

Whilst the refurbishment is underway, a temporary bridge will be installed, providing a single lane for vehicles (managed by traffic lights) with pedestrian access. However, road closures will be required for both the initial and final 3-4 week periods, to allow the bridge to be removed and the temporary one assembled, then vice versa. Short-term closures will also be needed periodically during the program, to enable the temporary bridge to be lifted, so that boats can access the dry dock.

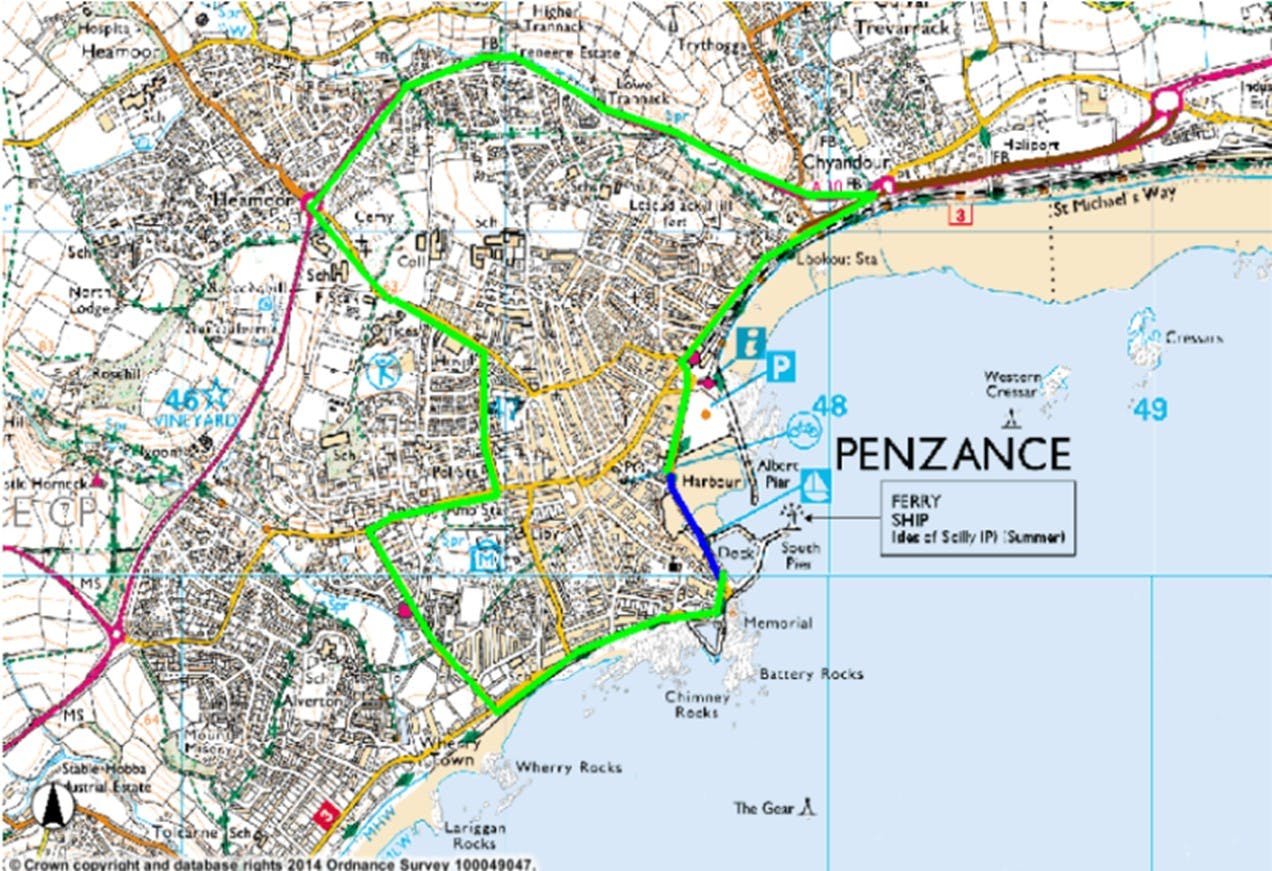

Advanced warning signs will be in place ahead of each closure, together with a fully signposted diversion route (highlighted here in green).

The Dry Dock and other nearby businesses remain open as usual, throughout the project.

Regular updates will be available on this page throughout the project.

If you have any queries or concerns please email: contracting@cormacltd.co.uk

or call us on 0300 1234 222

Overview and timeline of works and road closures

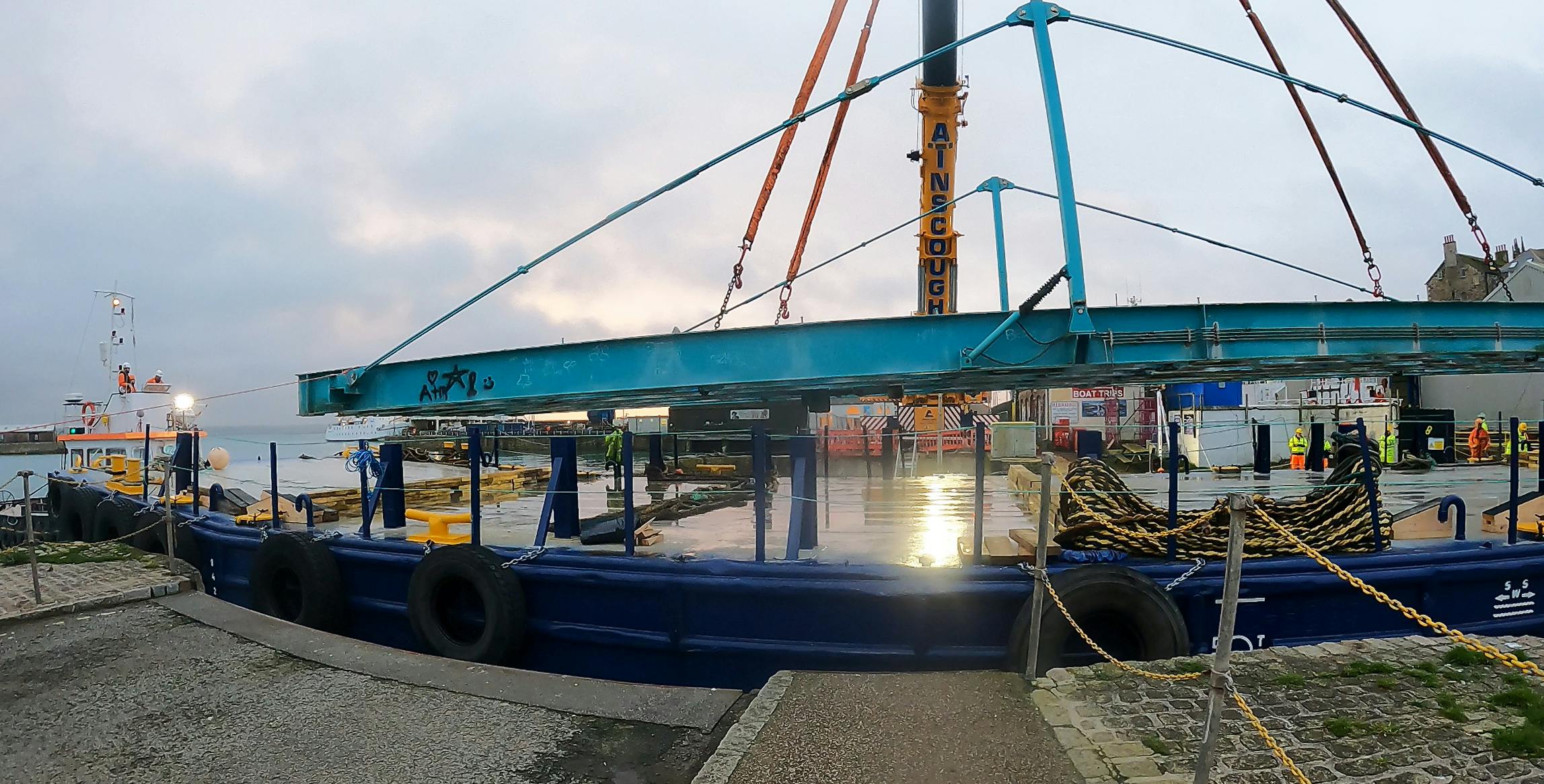

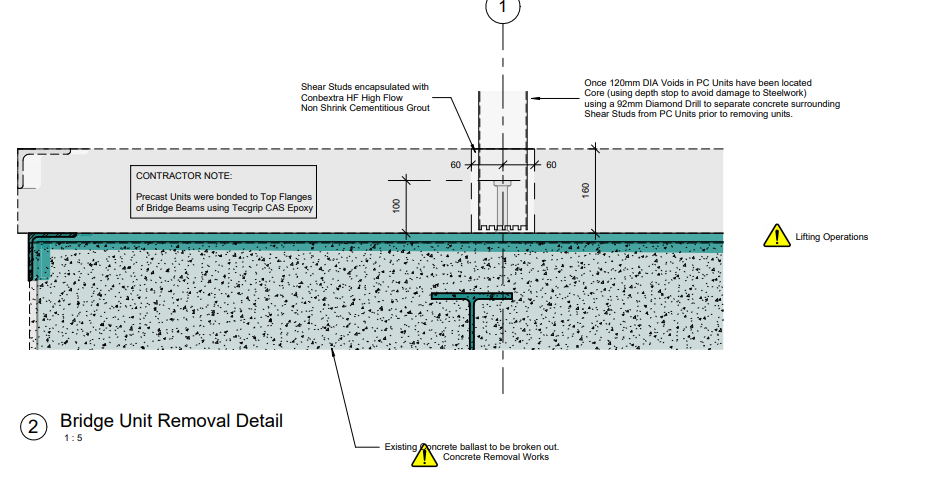

WEEK 1ROAD CLOSEDDisconnect utilities, lighting & cabling etc, remove deck & non structural components, remove weighting systems and connections and prepare for lifting.
WEEK 2

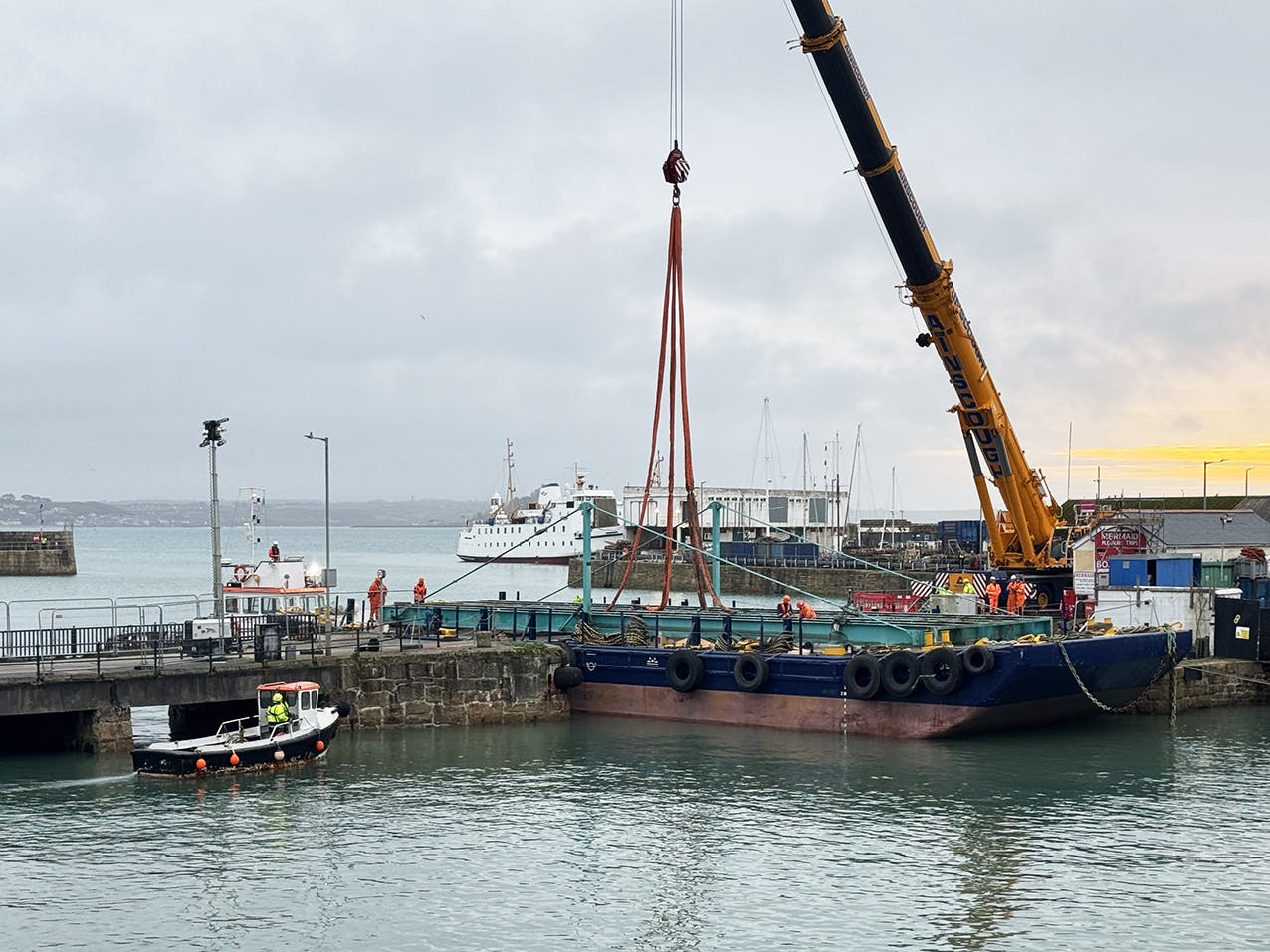

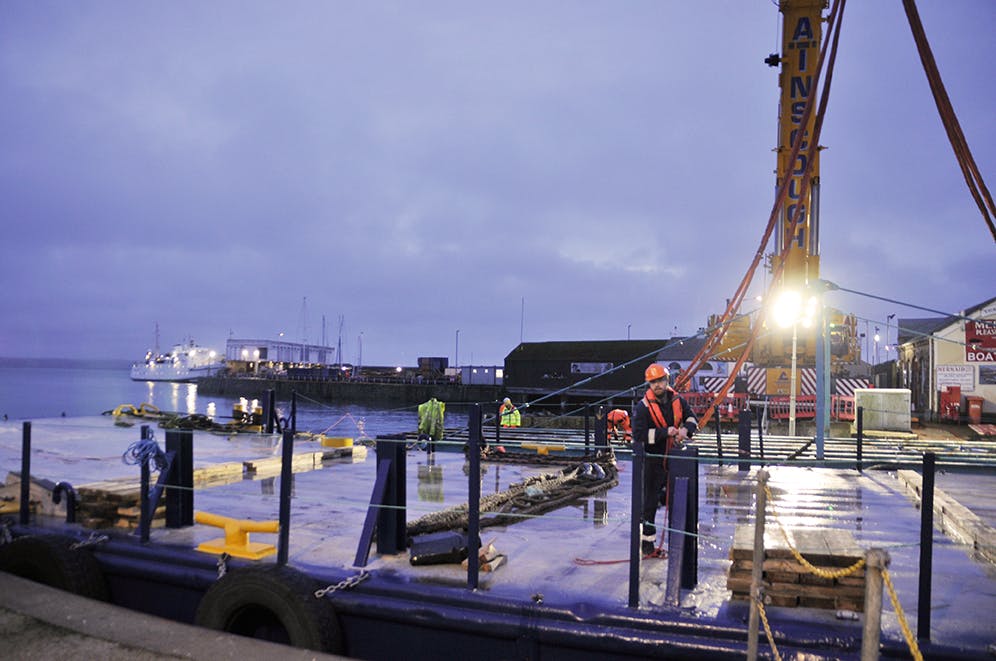

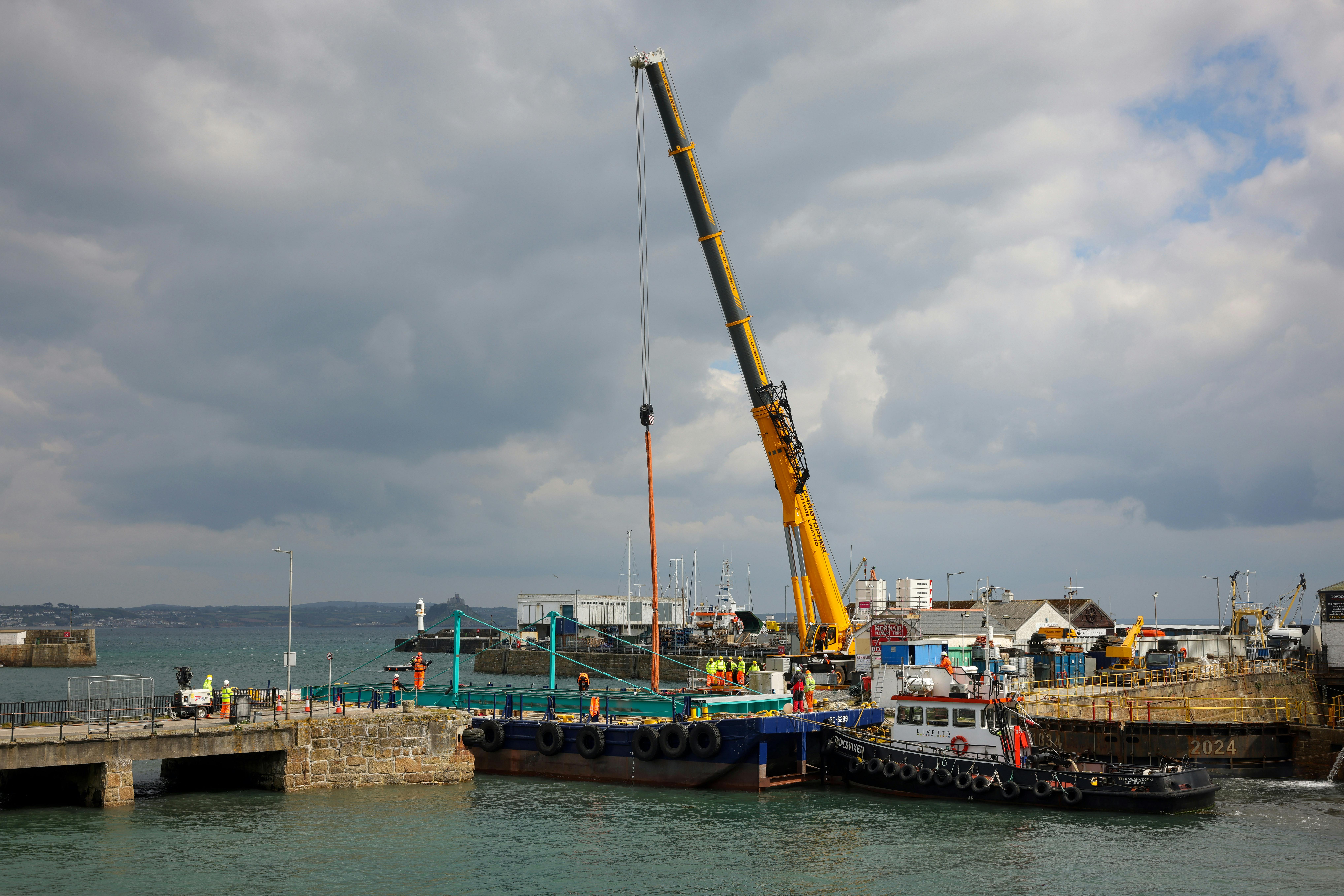

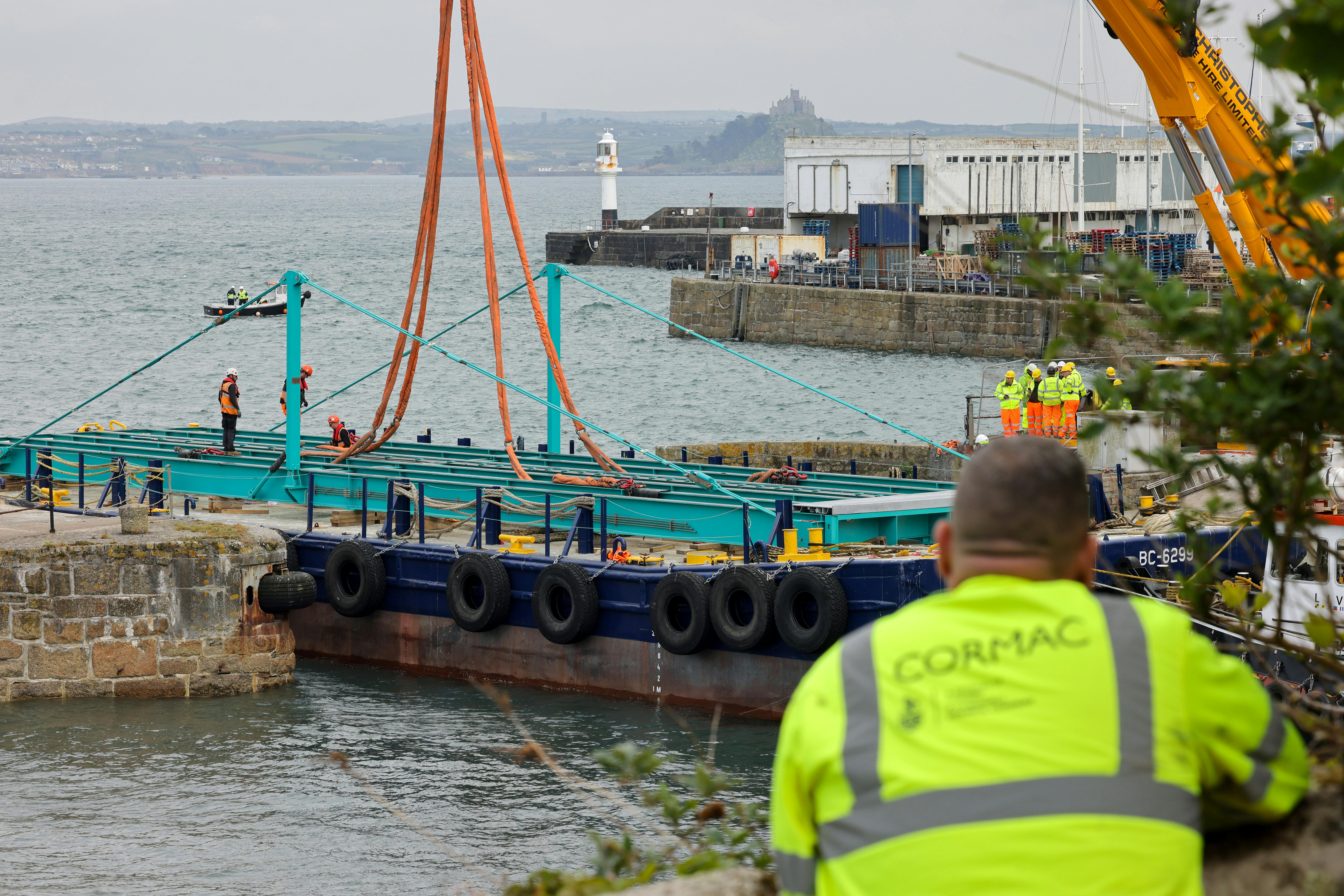

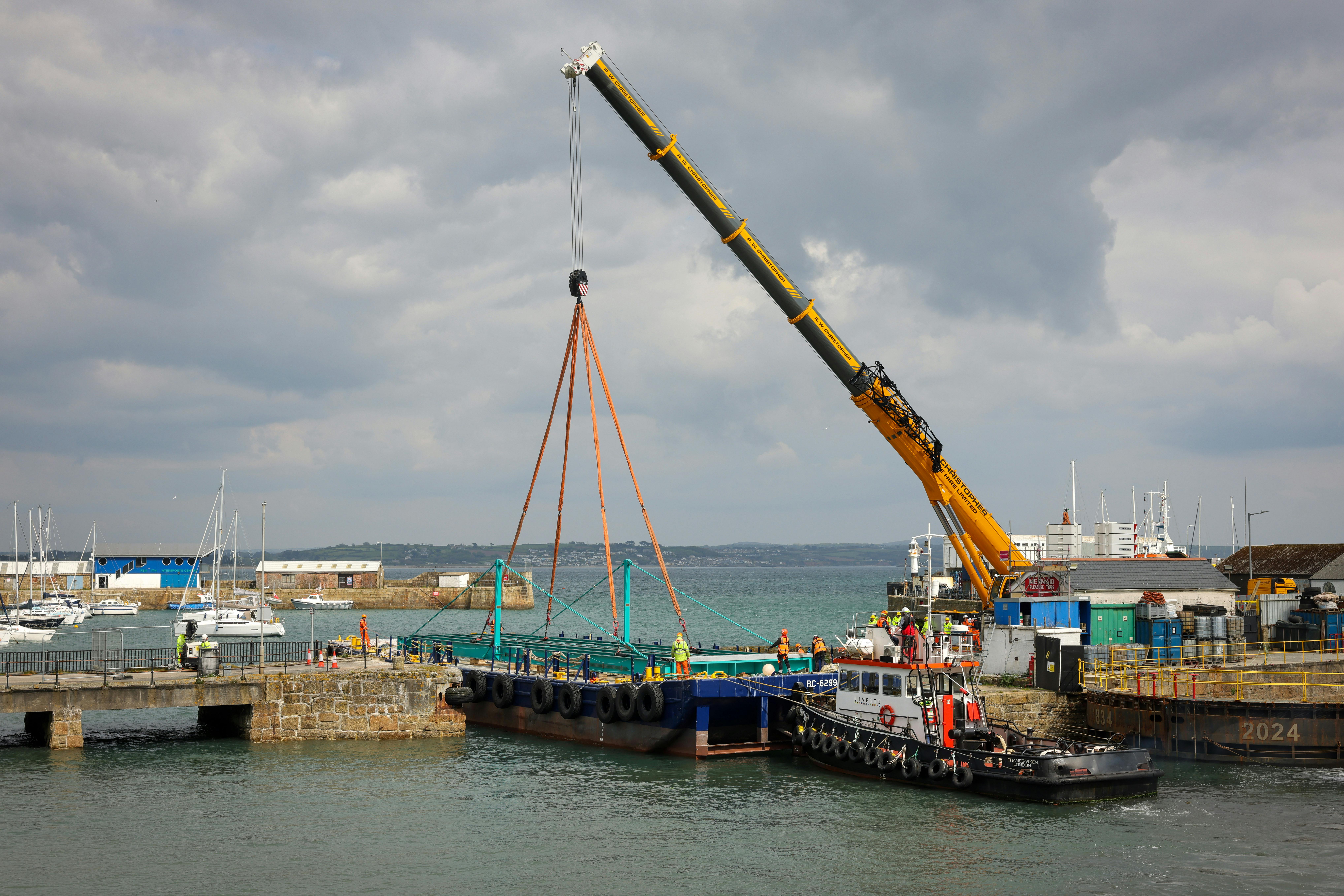

WEEK 3Controlled lift & removal for refurbishment. Lift temporary bridge in to place.

WEEK 4Install and connect temporary bridge.

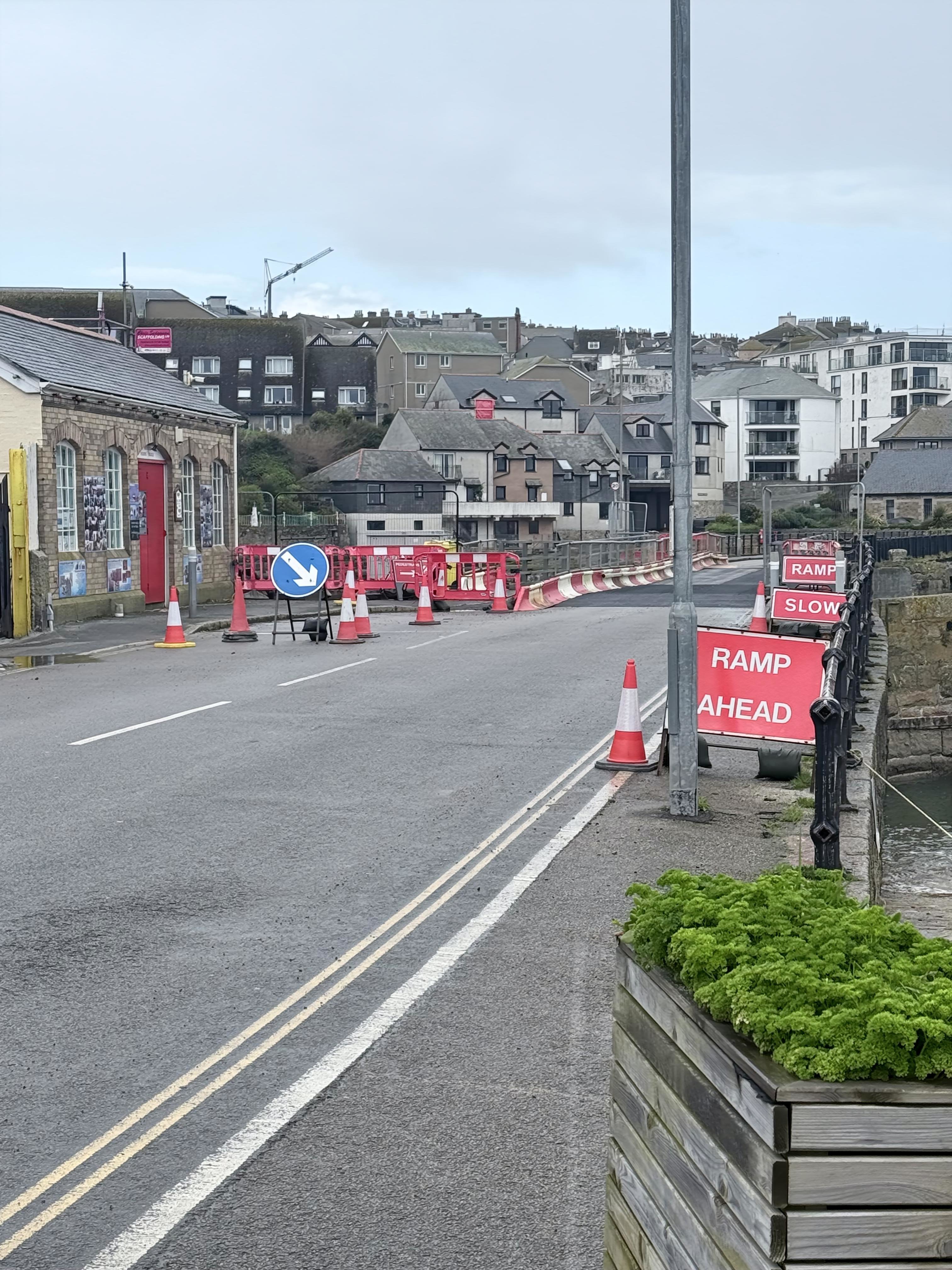

WEEK 5ROAD OPENSingle lane for vehicles, with two-way traffic lights and pedestrian access. Periodic short-term road closures to be advised, to allow lifting of the temporary bridge, giving access to the dry dock as required. Clearly signposted diversion route will be in place.
WEEK 6
WEEK 7
WEEK 8
WEEK 9
WEEK 10ROAD CLOSEDPreparation and disassembly of the temporary bridge, in readiness for it's lifting and removal.
WEEK 11

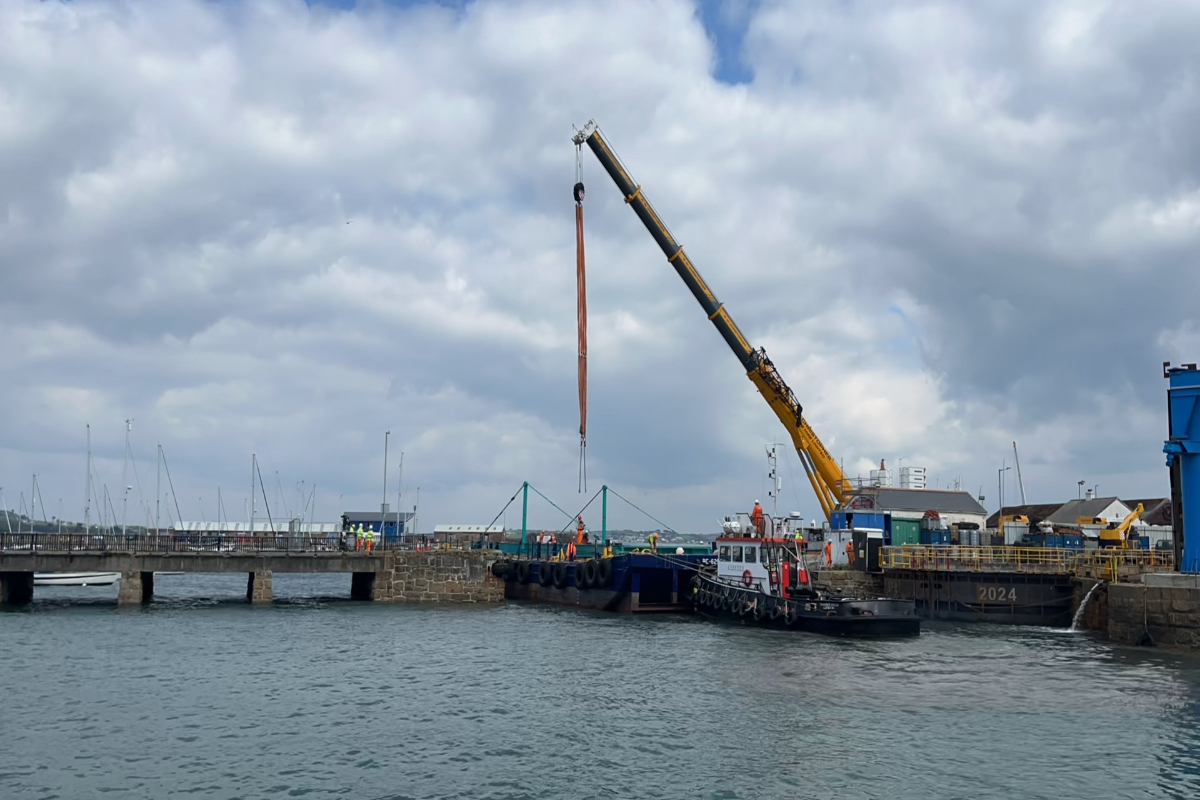

WEEK 12Install and connect refurbished bridge. Install deck and new surface. Carry out testing & certification in readiness for opening.
WEEK 13
WEEK 14ROAD OPENOpen and return to normal service.

NB Actual dates are to be confirmed and will be subject to change.
